Bunky the eBug: A 30 Day EV Conversion

Tell us about the project you do with the open inverter
Post Reply
User avatar
Gregski
Posts: 3164
Joined: Tue Sep 14, 2021 10:28 am
Location: Sacramento, California
Has thanked: 633 times
Been thanked: 1610 times
Contact:

Bunky the eBug: A 30 Day EV Conversion

Post by Gregski »

I was walking down the street minding my own business the other day,
when I saw a guy locking up a 7 Eleven convenience store,
hey buddy what do you think you're doing I asked.
Locking up! the man exclaimed
But the sign says Open 24 Hours.
Yeah, but not in a row, he retorted

Hmmm, that got me to thinkin', could I do an EV conversion in [ahem] 30 days?

So here are the RULES so far for the EV Conversion (and we get to make these up as we go along):
  • Rule # 1. Keep it Simple!
  • Rule # 2. When in doubt, refer to Rule # 1.
BUDGET: under $3,000 dollars (not including purchase price of the vehicle, or maybe even including it)
$1,200 - Battery Pack
$450 - Zombieverter VCU
$250 - Motor
$200 - Charger/DC-DC Converter
$100 - misc, fuses, relays, hoses, terminals
$90 - Inverter
$80 - GPS Speedometer
$80 - Single Din WiFi Radio Dispaly
$50 - partial Inverter Wire Harness
$30 - Throttle Pedal
$30 - Coolant Pump
$25 - partial Resolver Wire Harness
??? - ?????
====================
$2,585 - TOTAL

COMPONENTS
  • Inverter: Toyota Camry or Gen 3 Prius with the OEM internal logic board
TIME: 30 days or less (in EV Conversion Math, EVCM)

VEHICLE REQUIREMENTS:
  1. Must be my birth year.
  2. Can't be red, I hate red cars! (a shiet !)
  3. Should have IRS
GOALS / EXPECTATIONS / & PIPE DREAMS
  1. Less Means More - would love to use a single box All-In-One solution, Gen3 Prius Inverter, Controller (via internal logic board swap), DC-DC Converter, and even have it act as a charger [emphasis on Pipe Dream]
  2. Even Less Means Even More - no power steering, no power brakes, no air conditioning, no heater, no problems
  3. Range: 50 miles
  4. Tope Speed: [think captain slow] 60 MPH if that, this will be a city putt around car
  5. come up with a no welding required bolt in kit, fully reversible conversion (for that first human in history to actually attempt to reverse an EV
    Conversion)
  6. air cooled components in an air cooled people's car

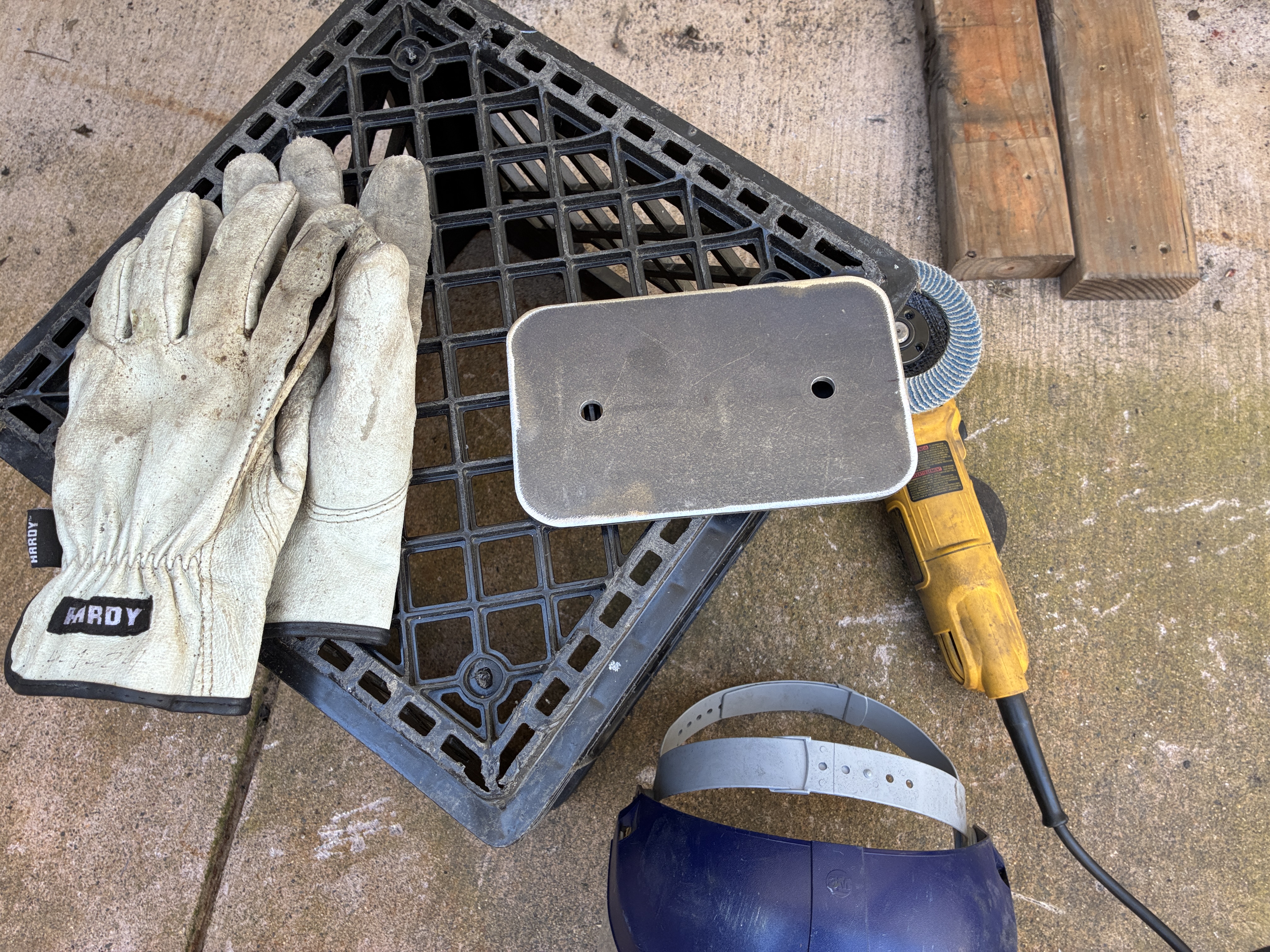

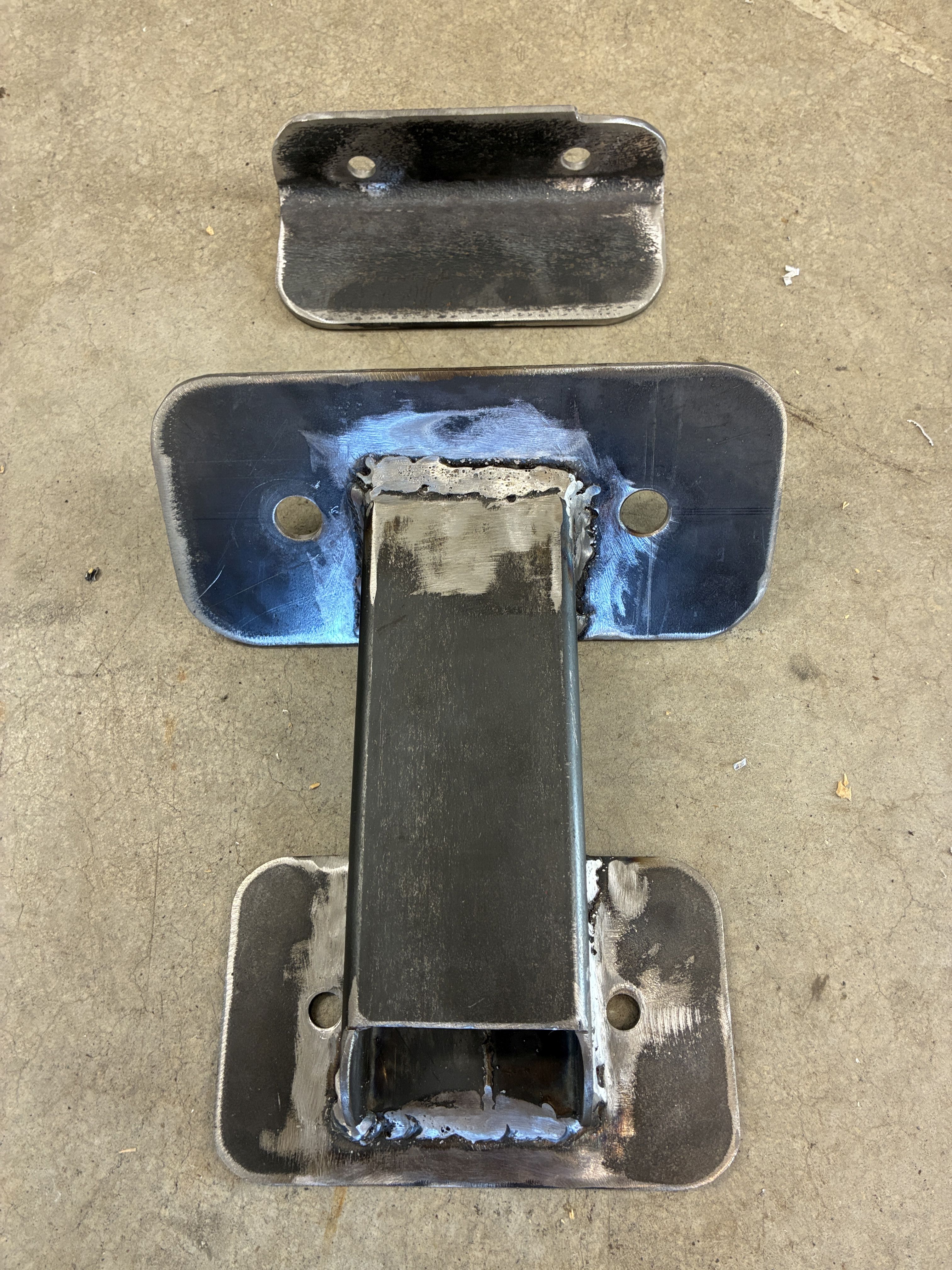

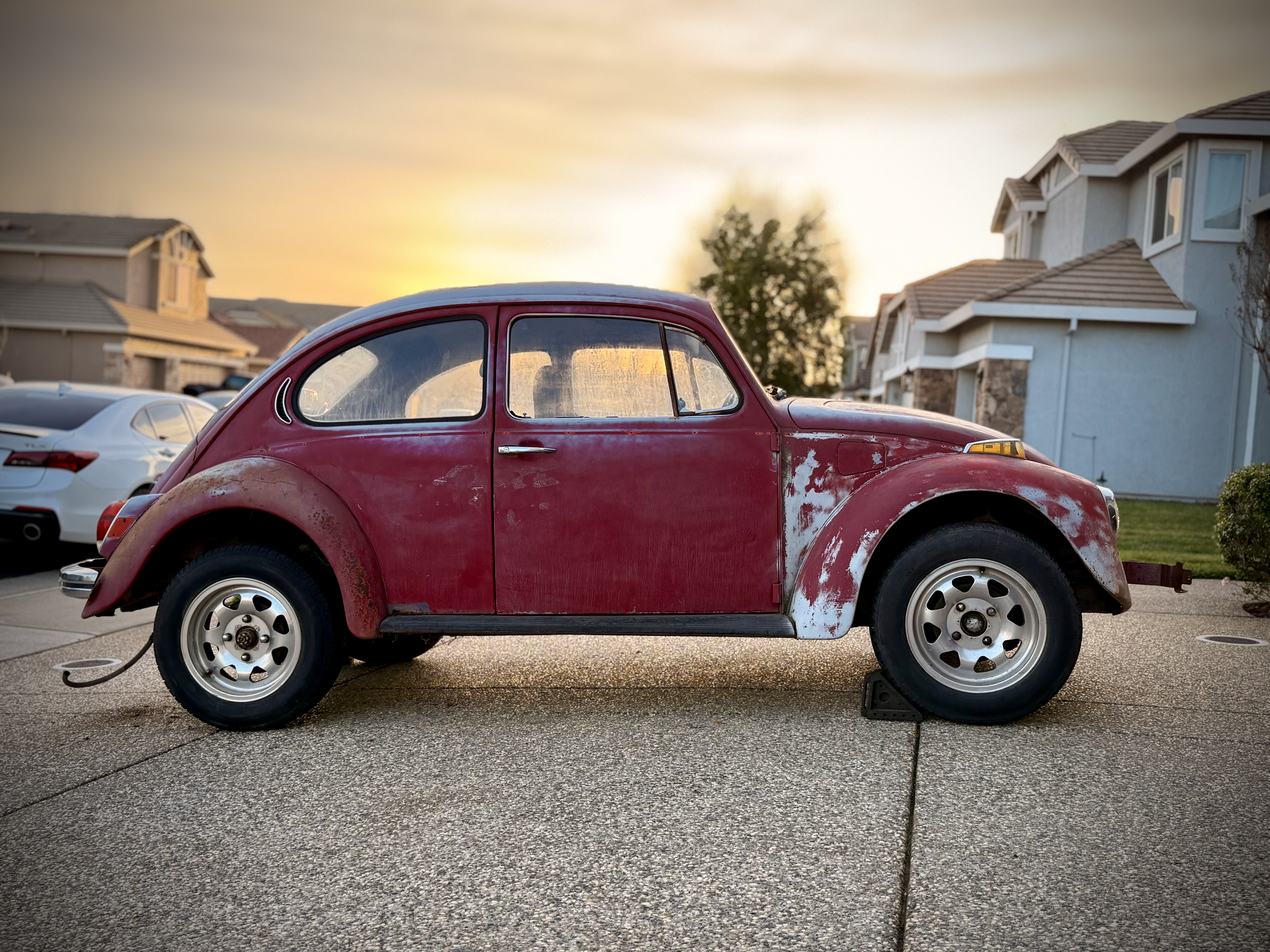

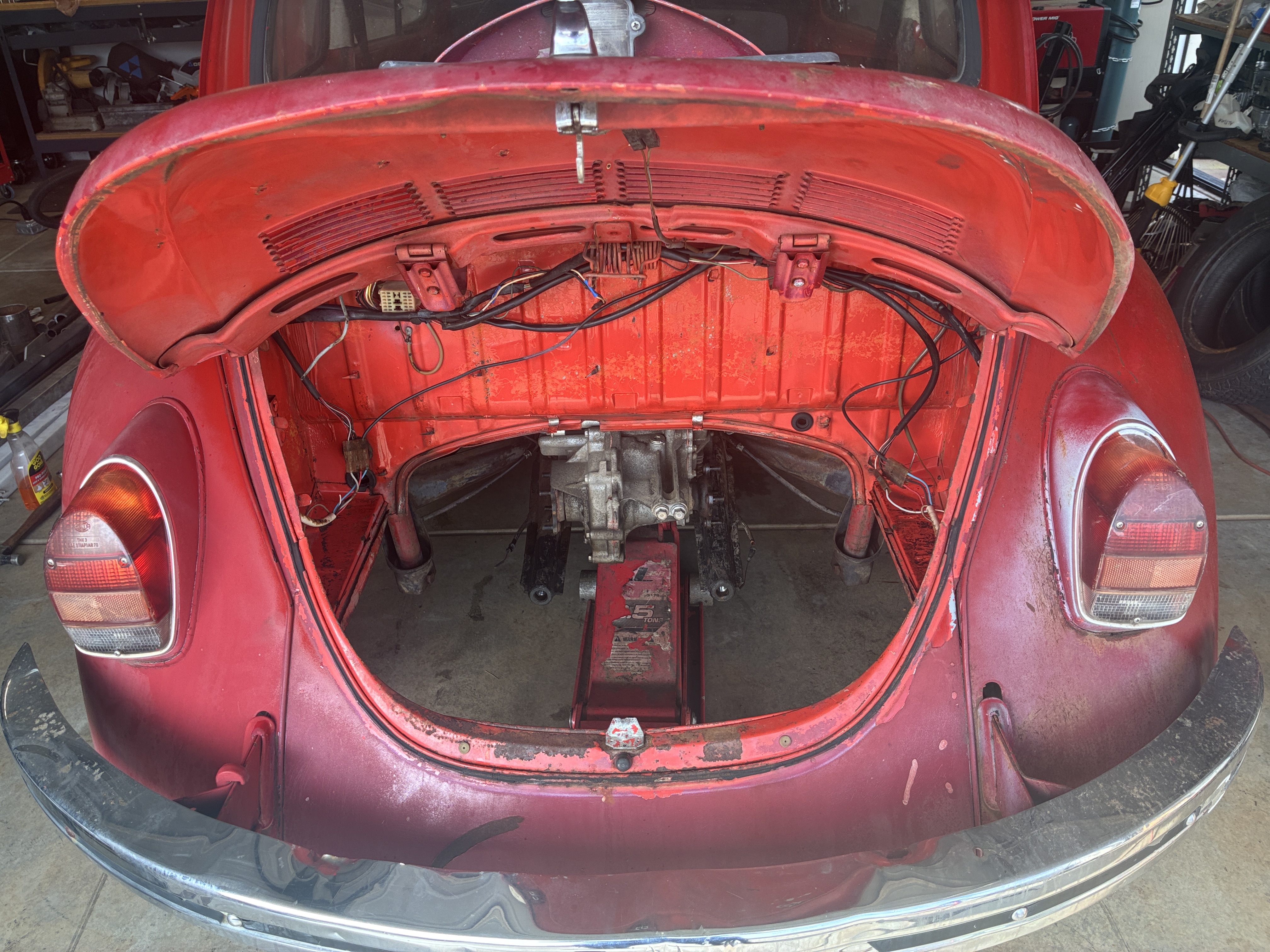

1972 VW Beetle Front.jpg

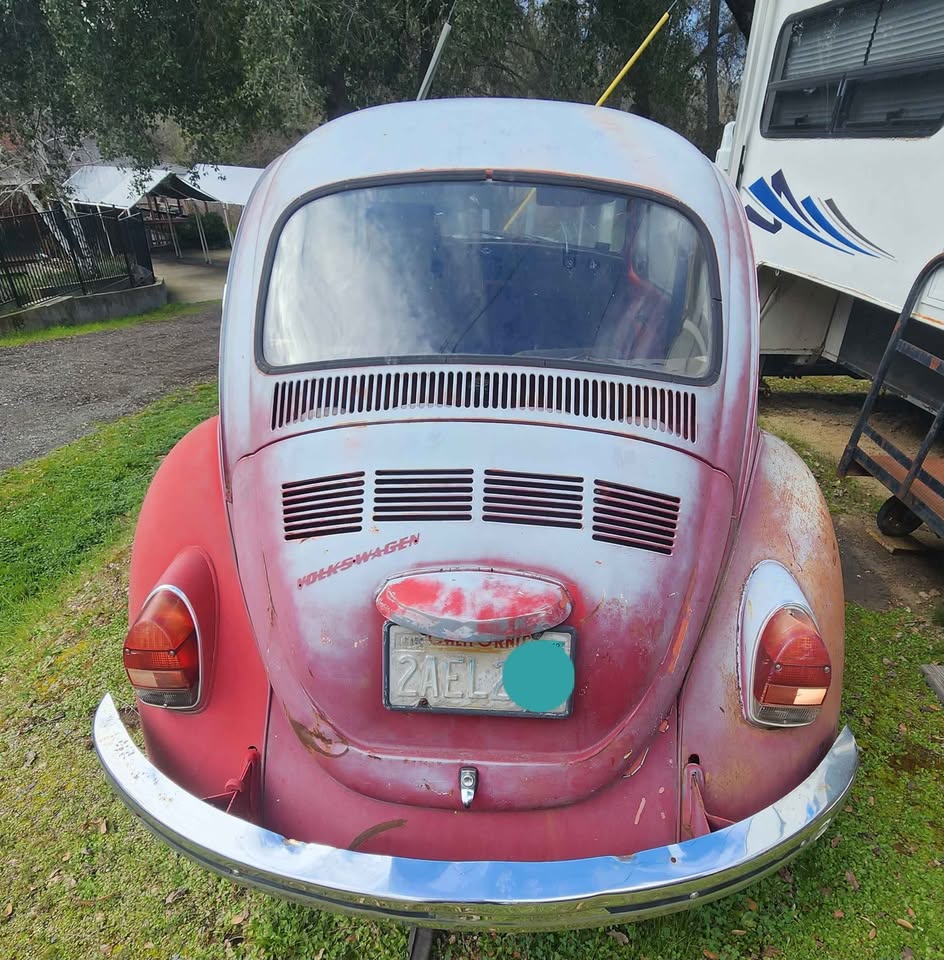

1972 VW Beetle Rear.jpg

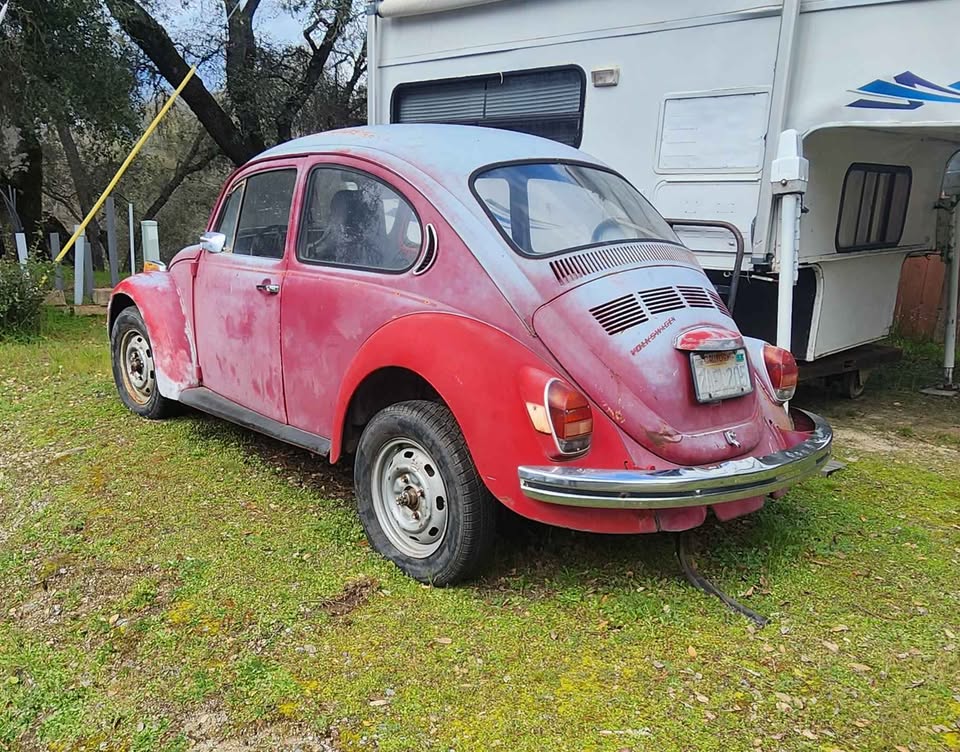

1972 VW Beetle Front Vertical.jpg
1972 VW Beetle Rear Vertical.jpg
"I don't need to understand how it works, I just need to understand how to make it work!" ~ EV Greg
User avatar
Gregski
Posts: 3164
Joined: Tue Sep 14, 2021 10:28 am
Location: Sacramento, California
Has thanked: 633 times
Been thanked: 1610 times
Contact:

Re: Bunky the eBug: A 30 Day EV Conversion

Post by Gregski »

so let's meet Bunky...

"I don't need to understand how it works, I just need to understand how to make it work!" ~ EV Greg
User avatar
Gregski
Posts: 3164
Joined: Tue Sep 14, 2021 10:28 am
Location: Sacramento, California
Has thanked: 633 times
Been thanked: 1610 times
Contact:

Re: Bunky the eBug: A 30 Day EV Conversion

Post by Gregski »

I pinky promise I will not liter this thread with non EV related updates as I tackle all the mundane restoration tasks on this magnificent automobile (and when I say restoration, I take that term very loosely) if you would like to keep up with those shenanigans please take a peak at my Bunky the eBug: A 30 Day EV Conversion thread on the VWVortex forum, please and thank you

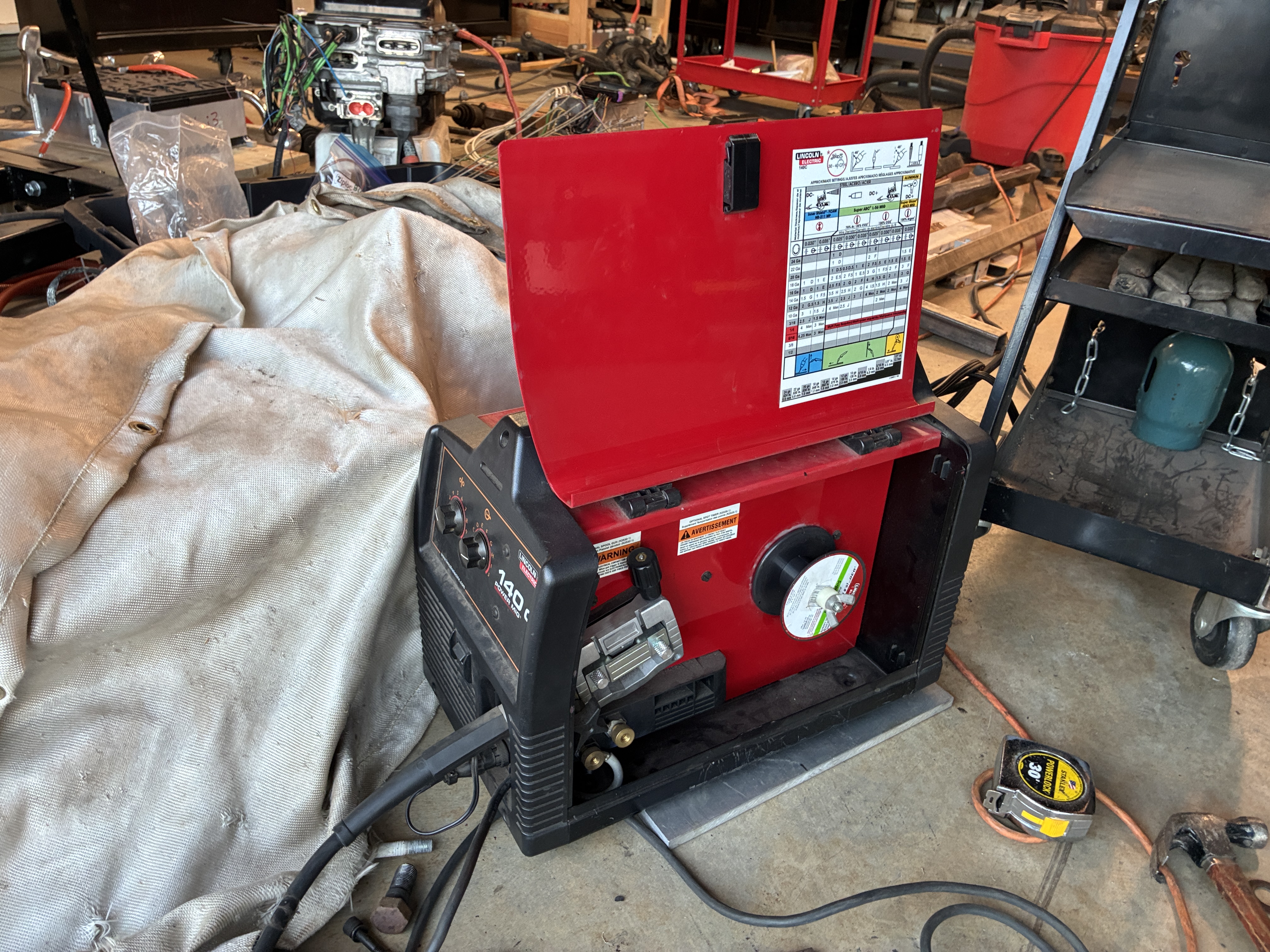

having said that, I just have to share this pic of her and her new shoes, how can you not love this sexy beast?

"I don't need to understand how it works, I just need to understand how to make it work!" ~ EV Greg
P.S.Mangelsdorf
Posts: 1230
Joined: Tue Sep 17, 2019 8:33 pm
Location: Raleigh, NC, USA
Has thanked: 323 times
Been thanked: 352 times

Re: Bunky the eBug: A 30 Day EV Conversion

Post by P.S.Mangelsdorf »

Damn, you're going to beat me to it! I've been thinking about and collecting parts for a similar low buck idea for a while, but keep letting other things get in the way. Excited to see how this goes!
If at first you don't succeed, buy a bigger hammer.

1940 Chevrolet w/ Tesla LDU - "Shocking Chevy" - Completed Hot Rod Drag Week 2023, 2024, and 2025

https://www.youtube.com/@MangelsdorfSpeed
User avatar
Gregski
Posts: 3164
Joined: Tue Sep 14, 2021 10:28 am
Location: Sacramento, California
Has thanked: 633 times
Been thanked: 1610 times
Contact:

Re: Bunky the eBug: A 30 Day EV Conversion

Post by Gregski »

P.S.Mangelsdorf wrote: Tue Feb 24, 2026 3:37 pm Damn, you're going to beat me to it! I've been thinking about and collecting parts for a similar low buck idea for a while, but keep letting other things get in the way. Excited to see how this goes!

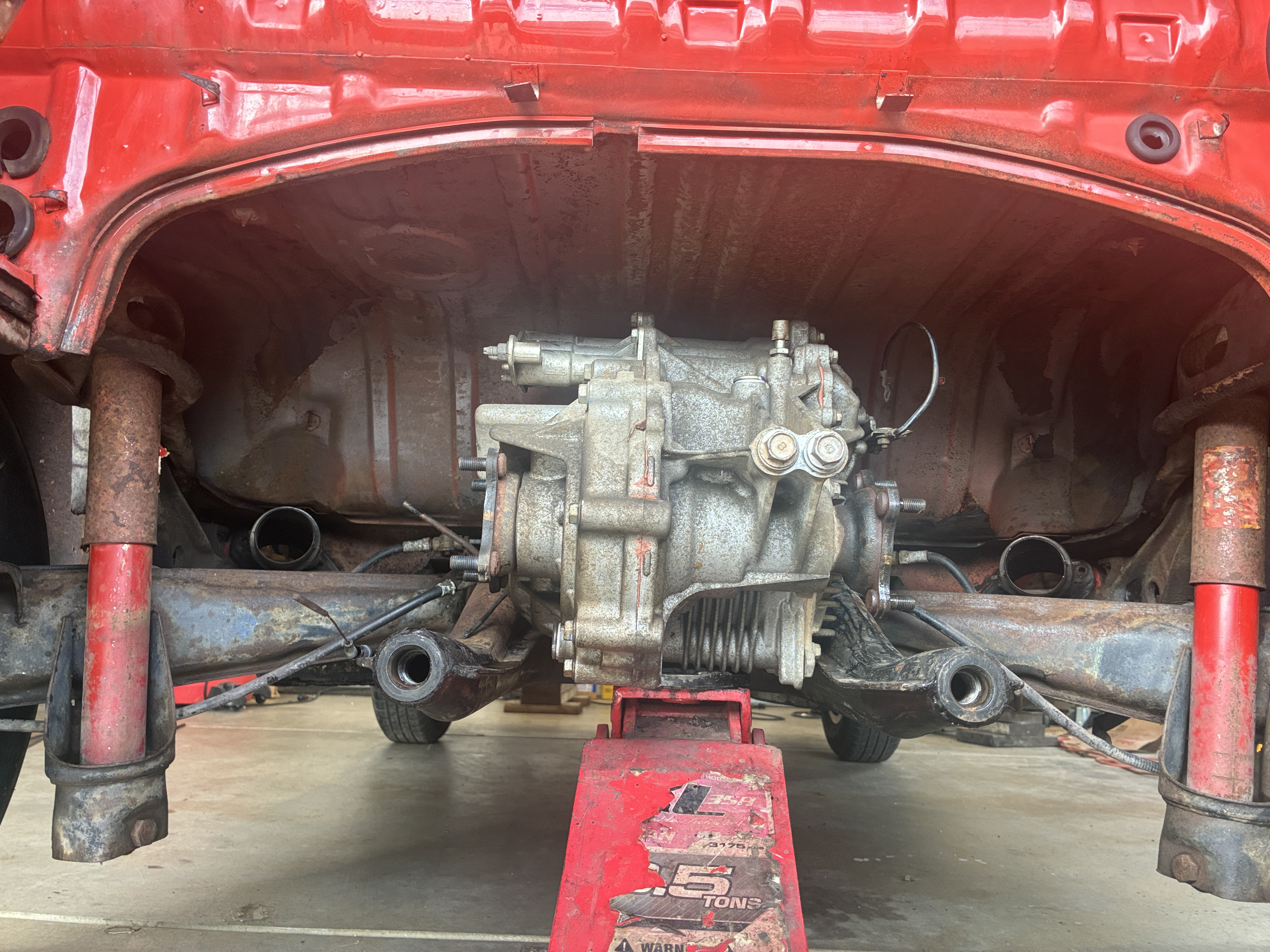

Oooh questions: What vehicle would you be converting? and I wonder if you have done any research to confirm if the following MGR source vehicles actually have the same motor specs:
  • Lexus RX450h
cause I know at least the Lexus RX400h rear track is narrower than the Toyota Highlander one, and may have different diameter CV axles and suspension linkage, which may matter to some, and I have not seen the RX450h in the Pick N Pull yards yet but I would love to get my hands on one of them as well, and then there's the elusive (in the State's anyways) Mitsubishi Outlander Rear Drive Unit
"I don't need to understand how it works, I just need to understand how to make it work!" ~ EV Greg
MattsAwesomeStuff
Posts: 1084
Joined: Fri Apr 26, 2019 5:40 pm
Has thanked: 479 times
Been thanked: 314 times

Re: Bunky the eBug: A 30 Day EV Conversion

Post by MattsAwesomeStuff »

I'm out of touch. I thought the MGR was no bueno because of... I forget why. Maybe people couldn't squeeze enough power out of it unless they had 600v? Then everyone jumped ship from Highlander to Outlander.

Haven't you done this "Conversion using X amount of time" thing before? I could've sworn it was the Rabbit but I just re-read some of that and, no, wasn't that.

What's Rule #1 of doing an EV Conversion?: Never do a restoration and a conversion at the same time.

And no one knows this better than you, someone who's done it twice before :P

Last time you started a build I said I'd be embarrassed if you got yours rolling before my 5-year project was. Cue embarrassment. Still not rolling, because I bought another car.

This time on only a 30 day deadline... okay fine. I'll throw my hat into the ring. I'm not doing a restoration and a conversion at the same time, I'm just doing a restoration OF a 46-year old EV conversion, that I haven't work on since July. In order to roll, it just needs brakes rebuilt. Temp battery and temp controller will get it rolling.

Bonus, it's also a VW Beetle (underneath):
P.S.Mangelsdorf
Posts: 1230
Joined: Tue Sep 17, 2019 8:33 pm
Location: Raleigh, NC, USA
Has thanked: 323 times
Been thanked: 352 times

Re: Bunky the eBug: A 30 Day EV Conversion

Post by P.S.Mangelsdorf »

Gregski wrote: Tue Feb 24, 2026 4:03 pm Oooh questions: What vehicle would you be converting? and I wonder if you have done any research to confirm if the following MGR source vehicles actually have the same motor specs:
Well I meant similar in the sense of limited budget, done quickly. I've been inspired by Casey's Customs on Youtube, where he's done a bunch of 'building a hot rod ______ for $_____" type builds. I picked up a Model 3 drive unit for $100 off of marketplace in the fall, and will probably use that, but I did just see that the local pick-a-part has a hybrid Yukon, and I've wanted to play with the 2ML70 (read: GM's 2 motor hybrid transmission from 2008-2013 Tahoe/Yukon/Escalade/Sierra/Silverado) so I might have to go grab that.

I don't have a car for it yet (though there is a '51 Jeep I bought for $100 years ago languishing in my parents' yard in NY. But honestly that's more of a pile of rust purporting to be a Jeep.) I was similarly thinking of something that already has independent suspension, and given my unmet penchant for Poncho power, I was looking around for a Fiero, or '61 Tempest, or '09-'10 Vibe.
Gregski wrote: Tue Feb 24, 2026 4:03 pm cause I know at least the Lexus RX400h rear track is narrower than the Toyota Highlander one, and may have different diameter CV axles and suspension linkage, which may matter to some, and I have not seen the RX450h in the Pick N Pull yards yet but I would love to get my hands on one of them as well,
I think that I saw a RX400 or 450 in a local yard here, I'll have to check on that.
If at first you don't succeed, buy a bigger hammer.

1940 Chevrolet w/ Tesla LDU - "Shocking Chevy" - Completed Hot Rod Drag Week 2023, 2024, and 2025

https://www.youtube.com/@MangelsdorfSpeed
User avatar
Gregski
Posts: 3164
Joined: Tue Sep 14, 2021 10:28 am
Location: Sacramento, California
Has thanked: 633 times
Been thanked: 1610 times
Contact:

Re: Bunky the eBug: A 30 Day EV Conversion

Post by Gregski »

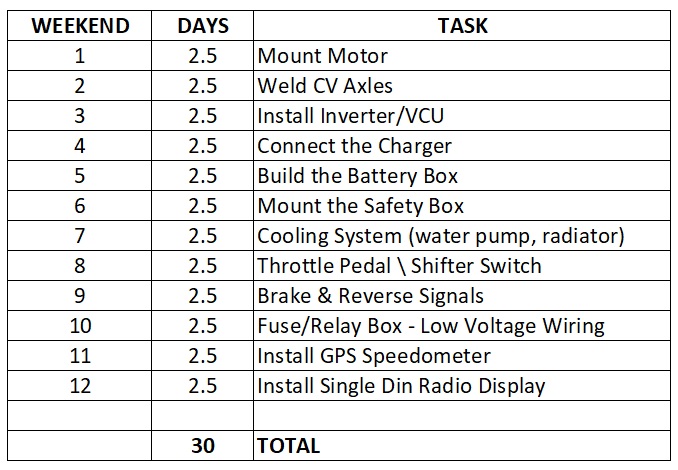

here's the proposed Bunky Build Schedule once we get started, which I hope will be in March, aka March Madness 2026, and I know some of the tasks won't take an entire weekend so they include some buffer time as well, also realistically I doubt I will be able to wrench on Bunky for 12 consecutive weekends, lemme know if you wanna come down and help, ha ha (cold tacos and warm beer shall be served)

2.5 days means start after work on Friday hence the half day, then all day Saturday and all day Sunday type of pace

Bunky Build Schedule.jpg
"I don't need to understand how it works, I just need to understand how to make it work!" ~ EV Greg
P.S.Mangelsdorf
Posts: 1230
Joined: Tue Sep 17, 2019 8:33 pm
Location: Raleigh, NC, USA
Has thanked: 323 times
Been thanked: 352 times

Re: Bunky the eBug: A 30 Day EV Conversion

Post by P.S.Mangelsdorf »

Gregski wrote: Thu Feb 26, 2026 2:25 pm lemme know if you wanna come down and help, ha ha (colt tacos and warm beer shall be served)
If I wasn't on the other side of the continent, I'd take you up on that offer.
If at first you don't succeed, buy a bigger hammer.

1940 Chevrolet w/ Tesla LDU - "Shocking Chevy" - Completed Hot Rod Drag Week 2023, 2024, and 2025

https://www.youtube.com/@MangelsdorfSpeed
User avatar
Gregski
Posts: 3164
Joined: Tue Sep 14, 2021 10:28 am
Location: Sacramento, California
Has thanked: 633 times
Been thanked: 1610 times
Contact:

Re: Bunky the eBug: A 30 Day EV Conversion

Post by Gregski »

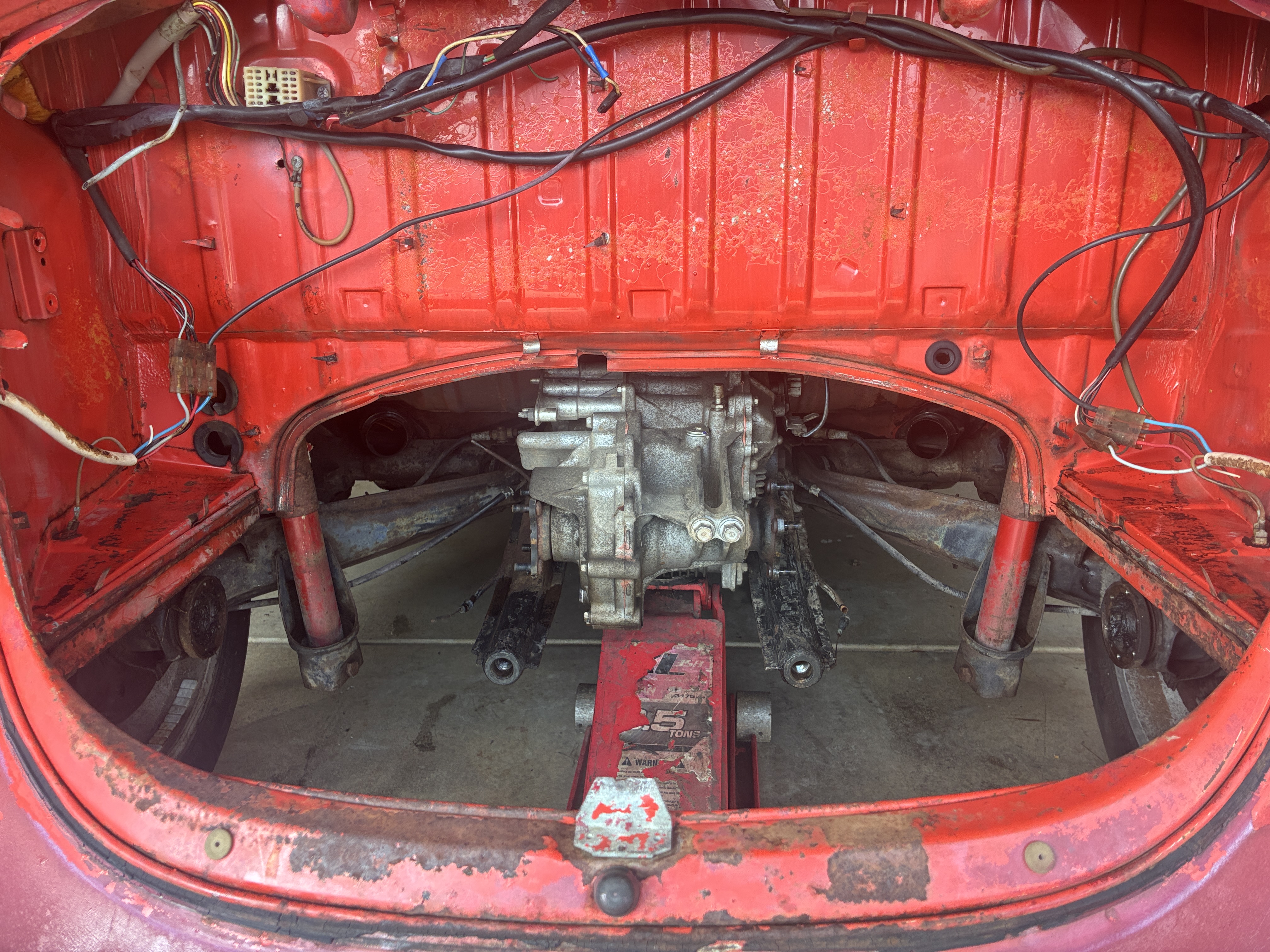

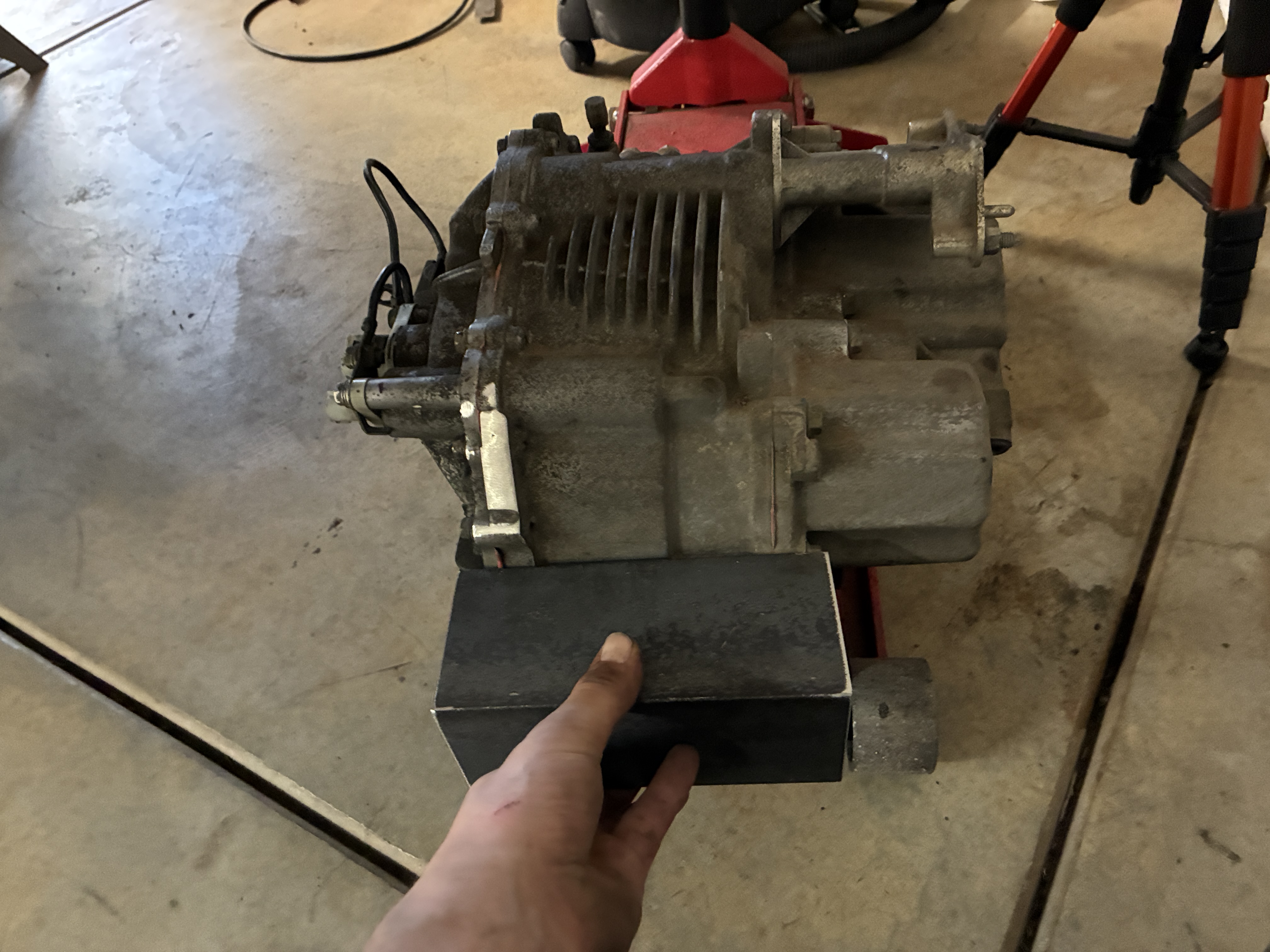

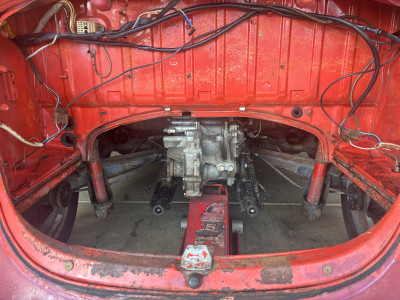

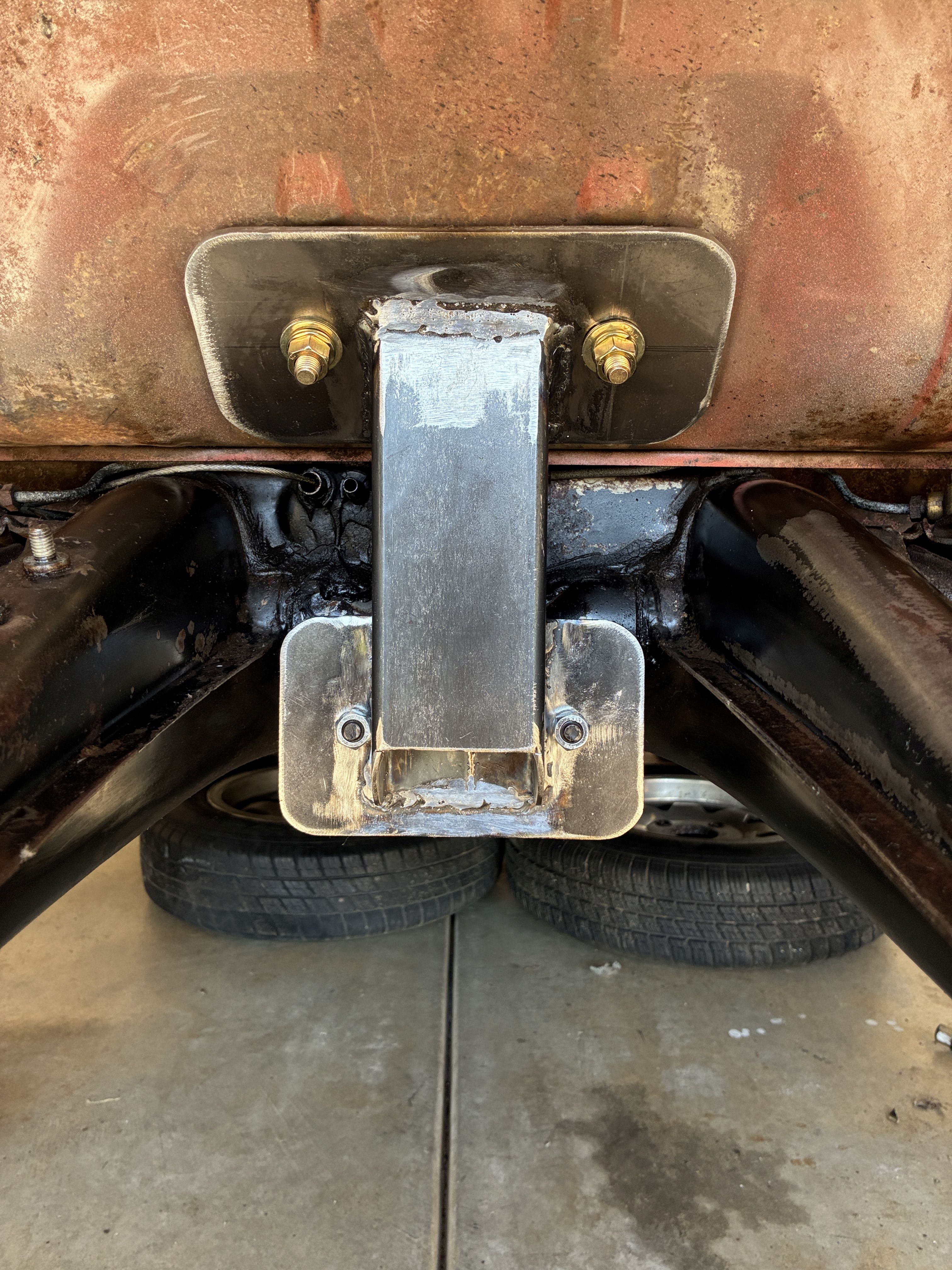

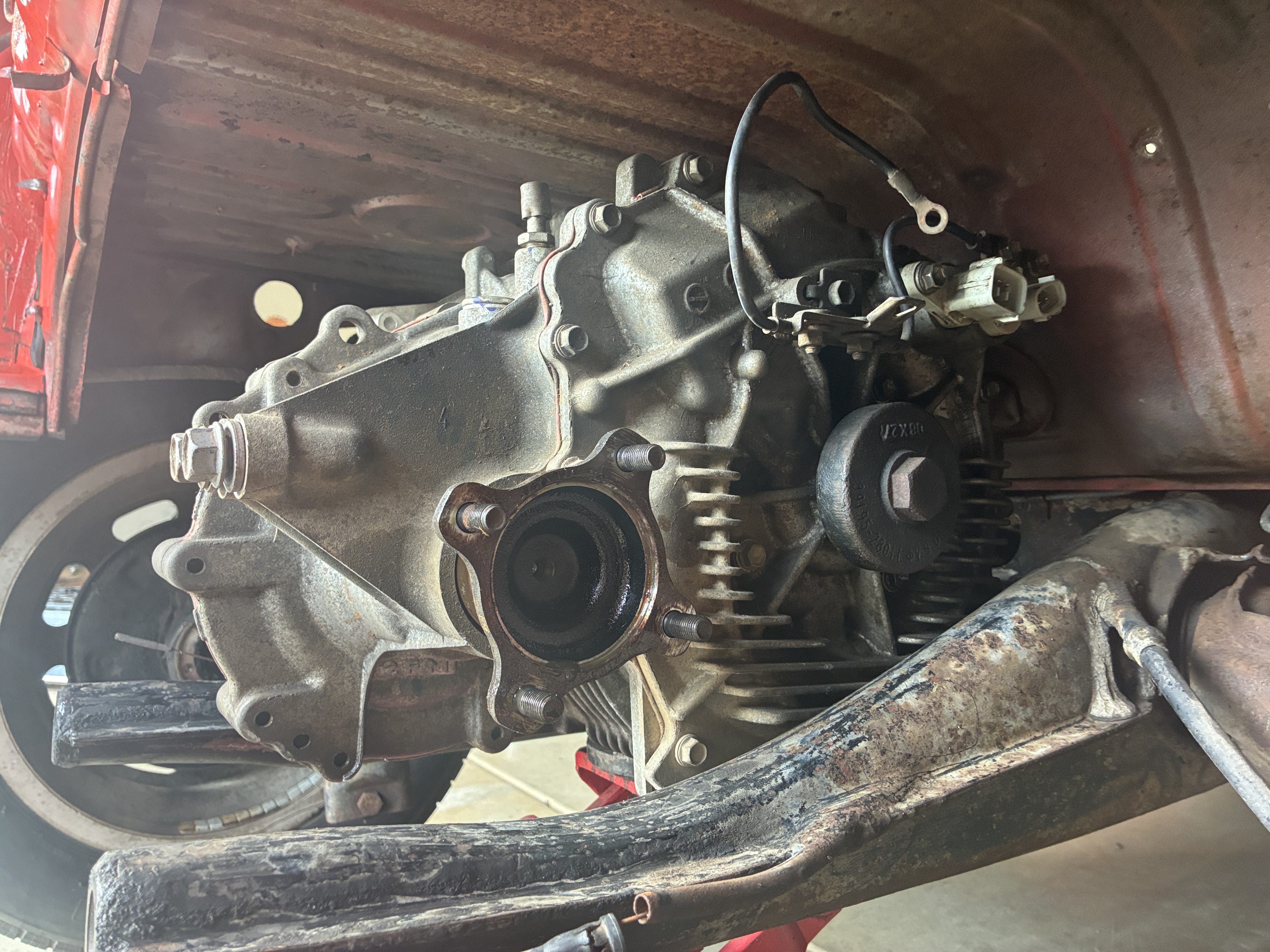

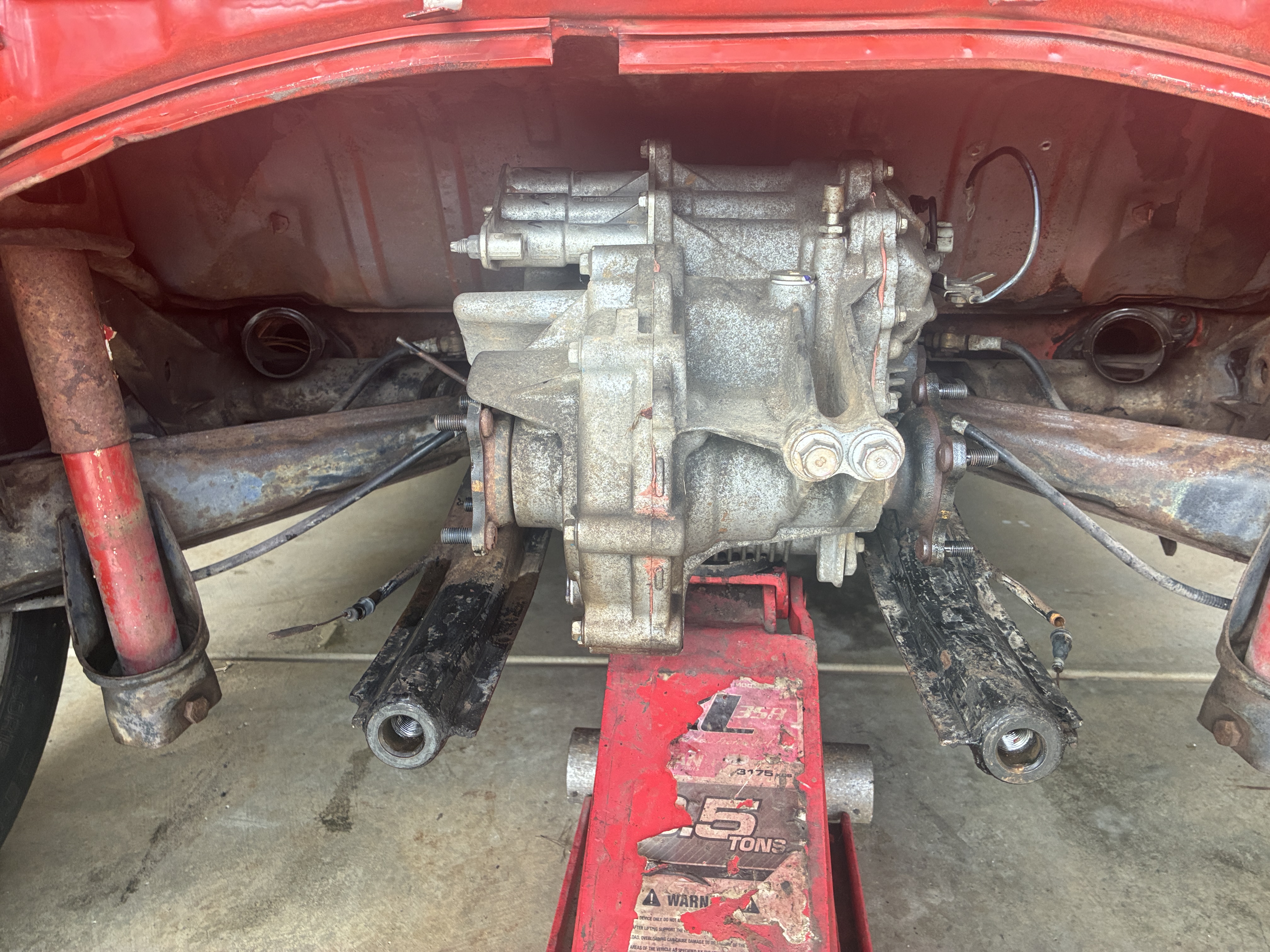

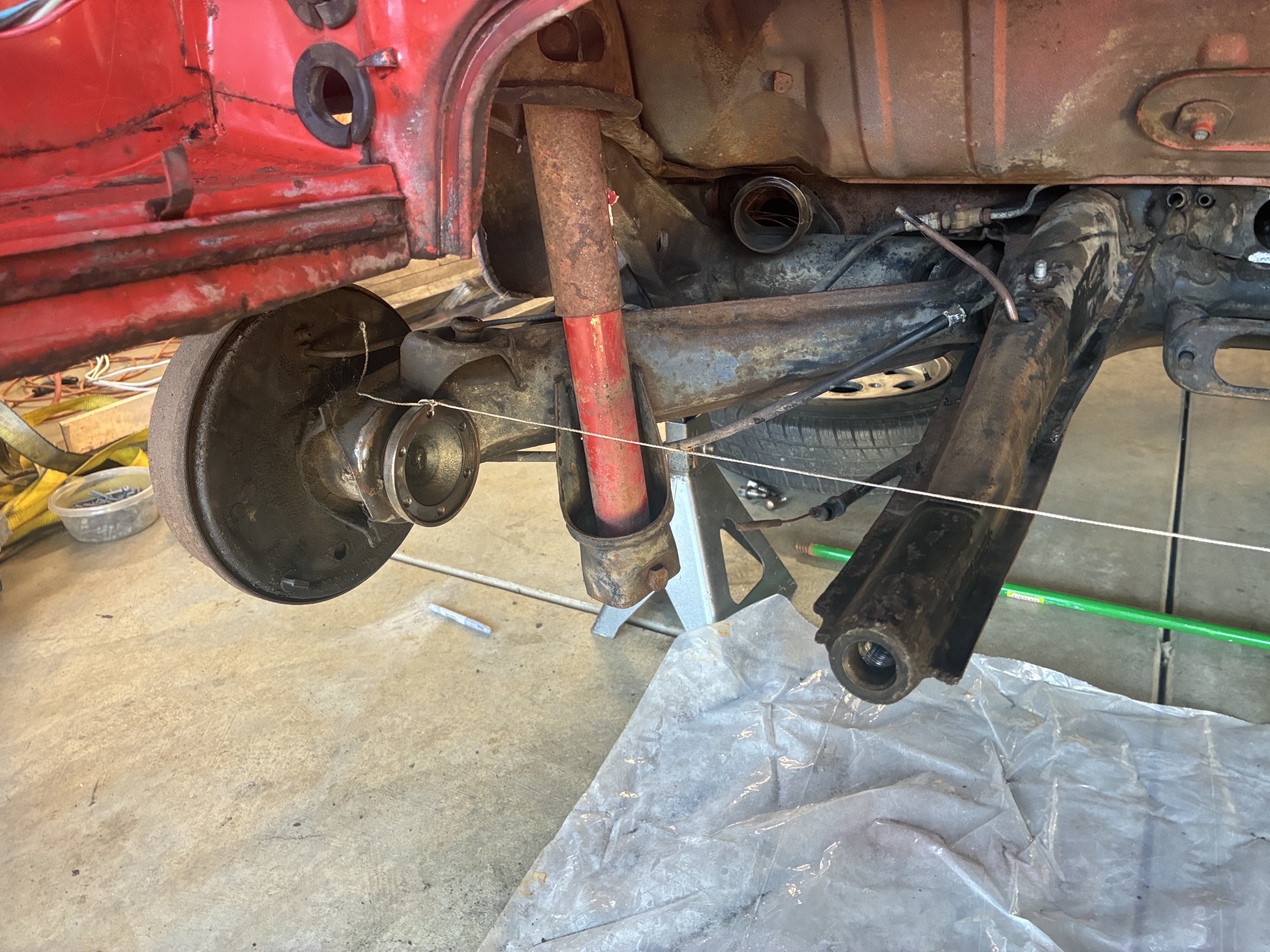

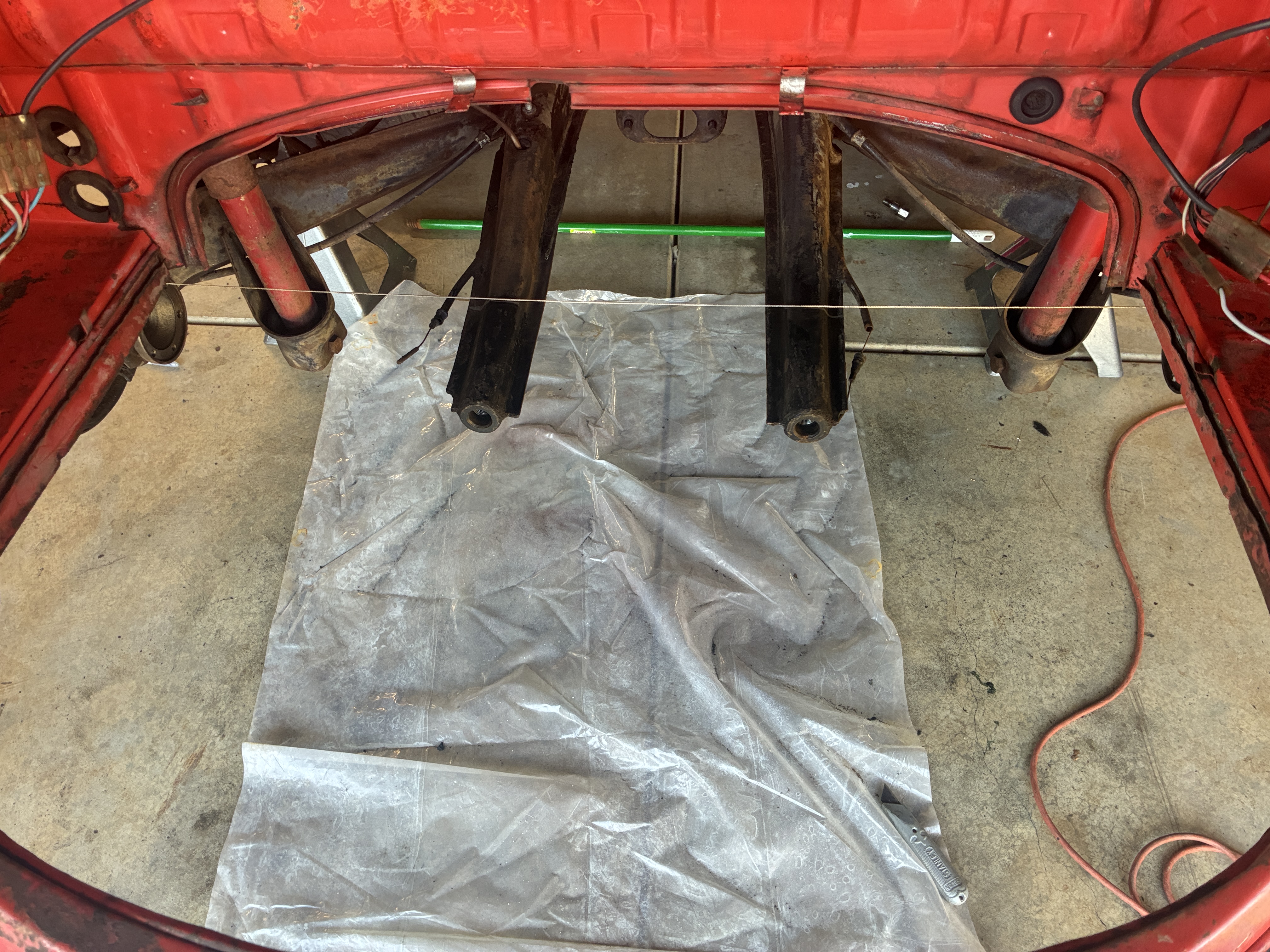

fits like a glove

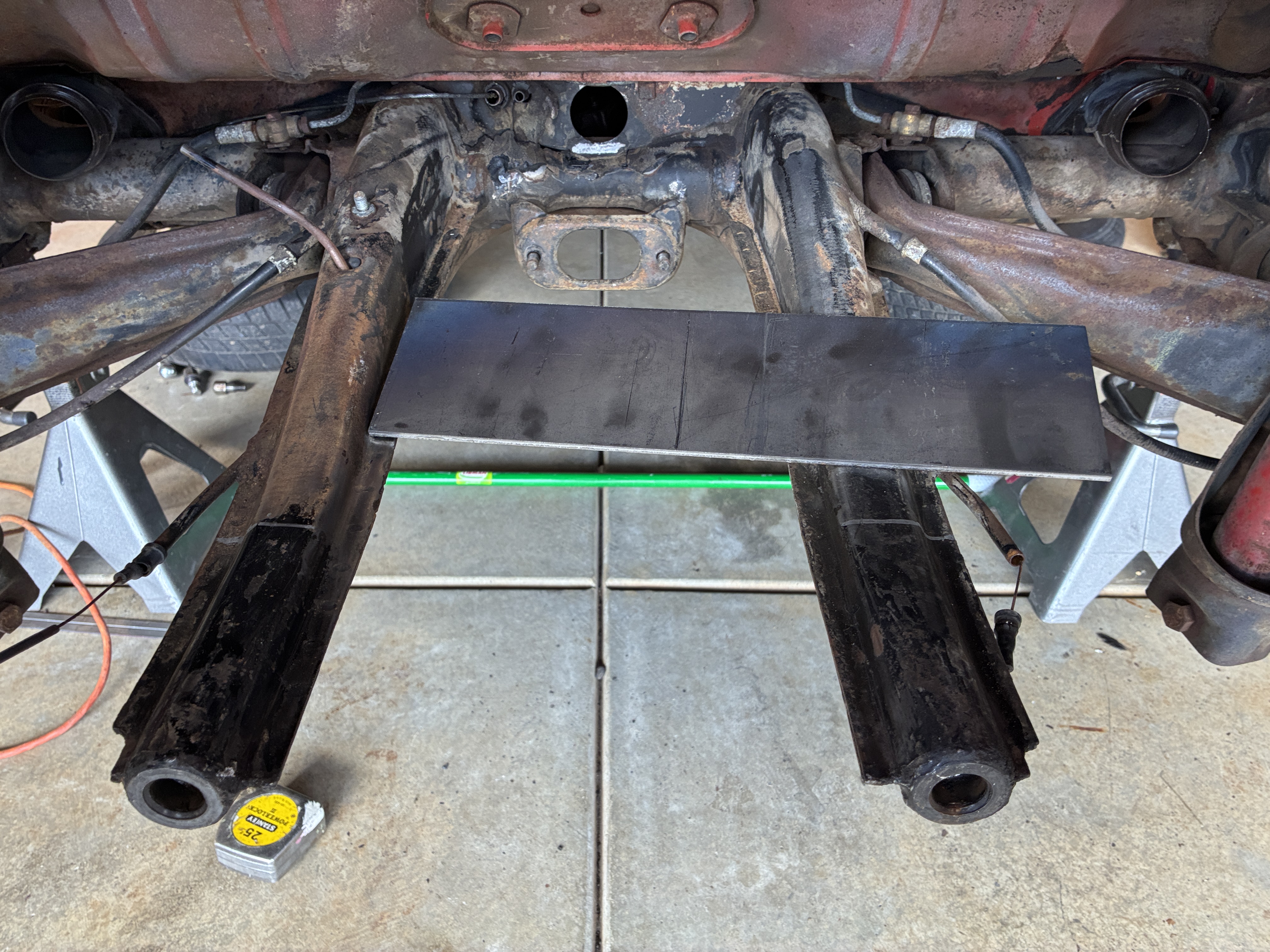

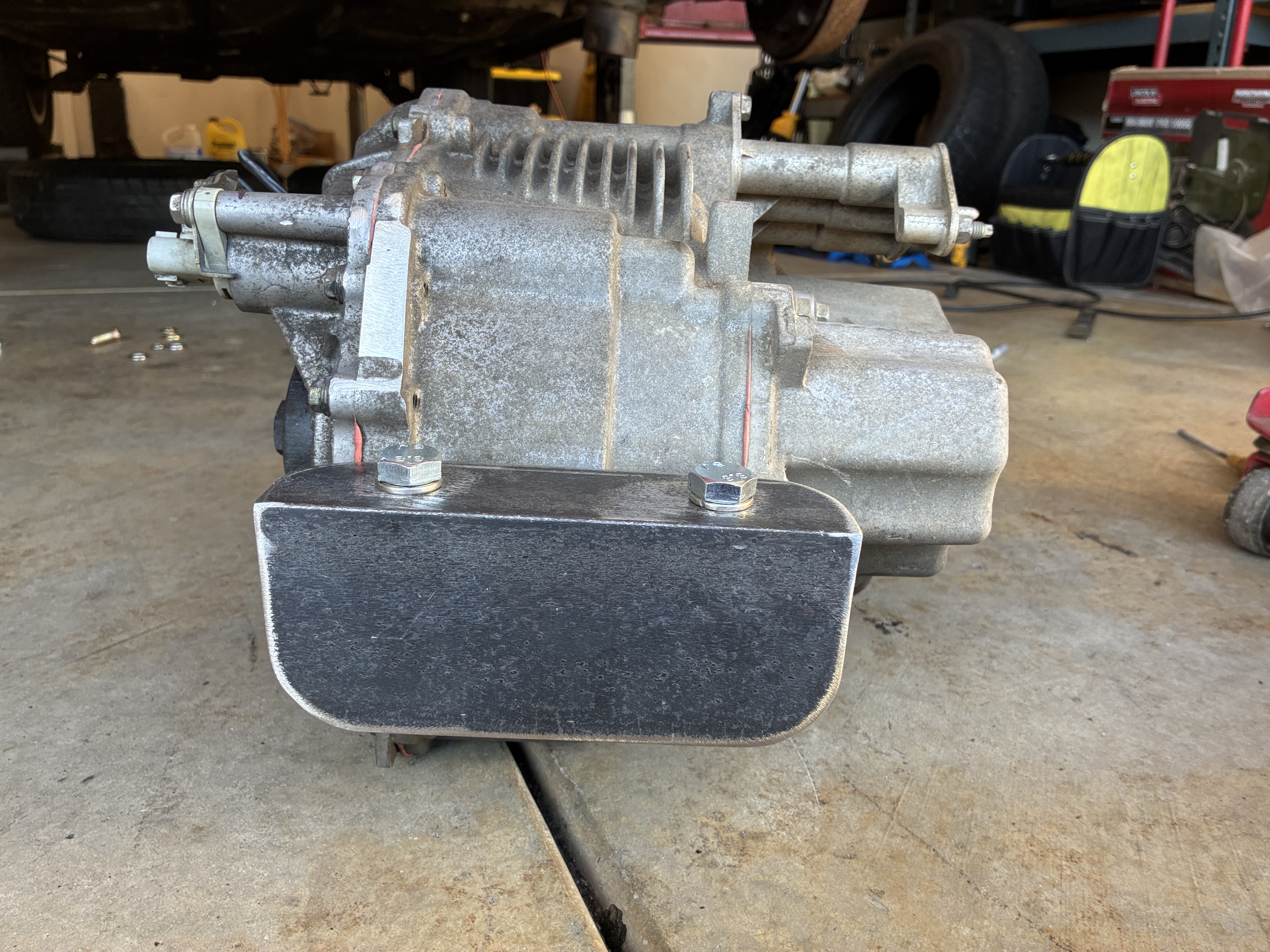

plenty of room in front (or behind the motor) depending how you look at it, for the inverter and charger
"I don't need to understand how it works, I just need to understand how to make it work!" ~ EV Greg
User avatar
Gregski
Posts: 3164
Joined: Tue Sep 14, 2021 10:28 am
Location: Sacramento, California
Has thanked: 633 times
Been thanked: 1610 times
Contact:

Re: Bunky the eBug: A 30 Day EV Conversion

Post by Gregski »

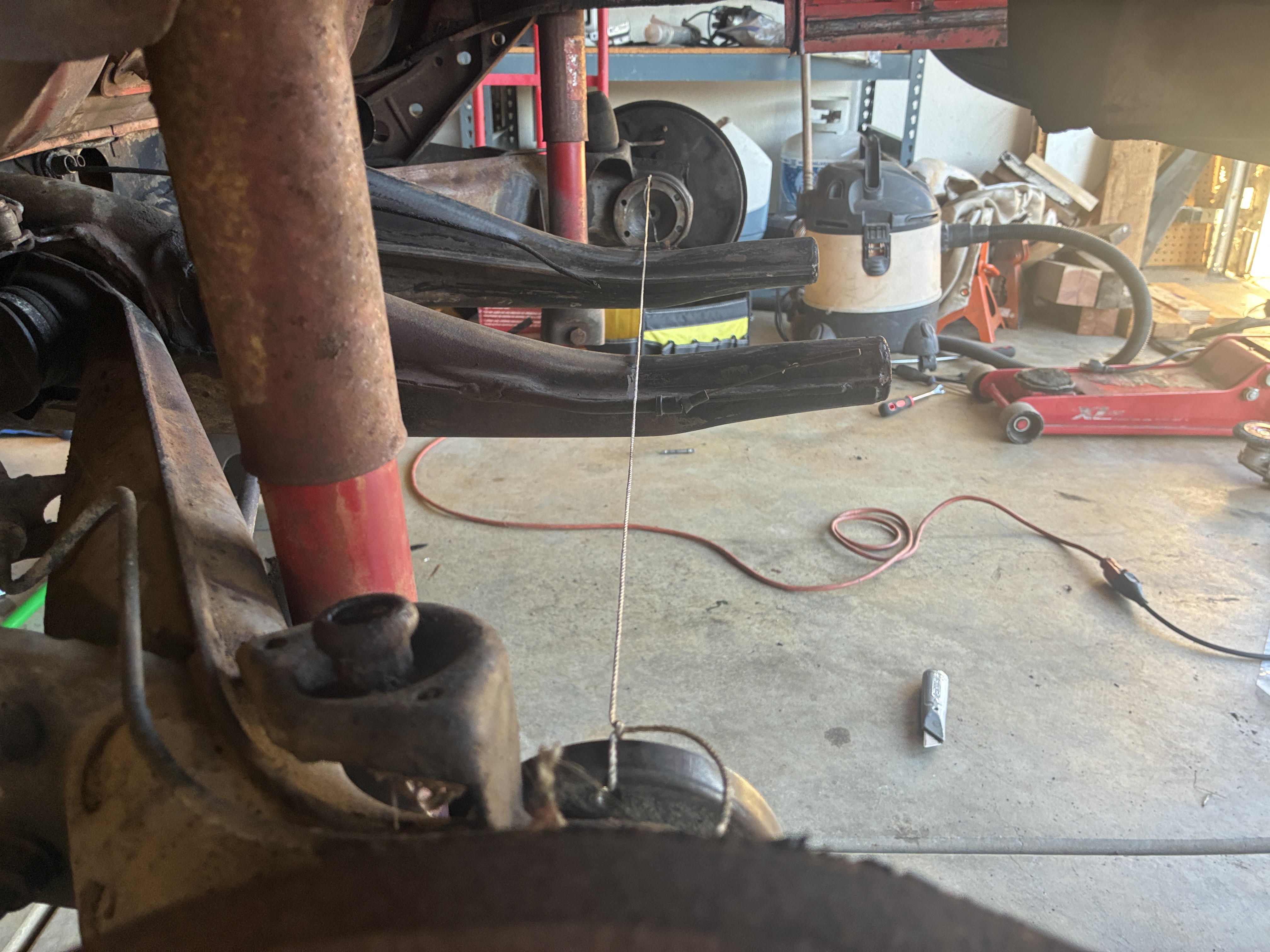

Stringanometry

"I don't need to understand how it works, I just need to understand how to make it work!" ~ EV Greg
User avatar
Gregski
Posts: 3164
Joined: Tue Sep 14, 2021 10:28 am
Location: Sacramento, California
Has thanked: 633 times
Been thanked: 1610 times
Contact:

Re: Bunky the eBug: A 30 Day EV Conversion

Post by Gregski »

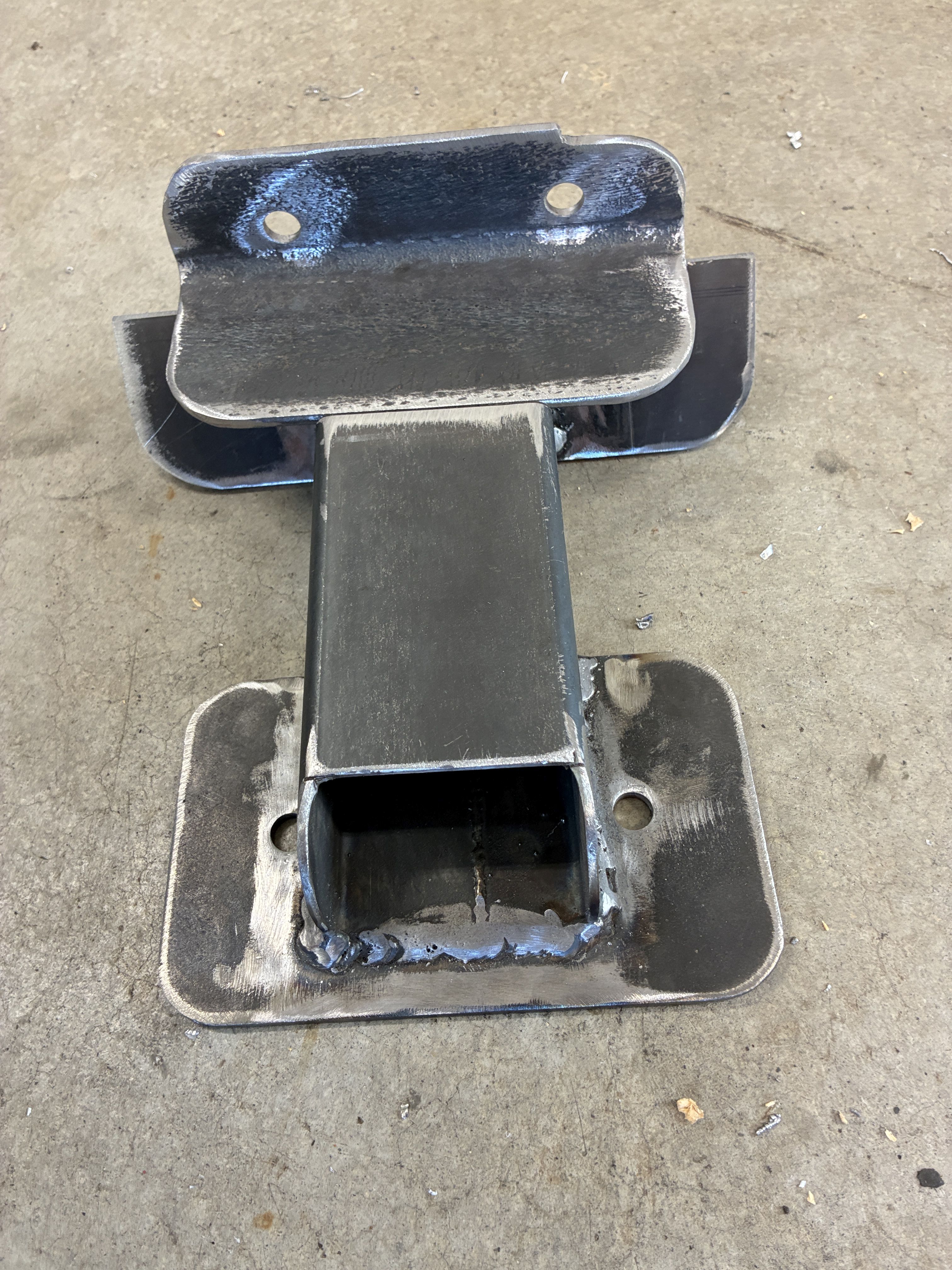

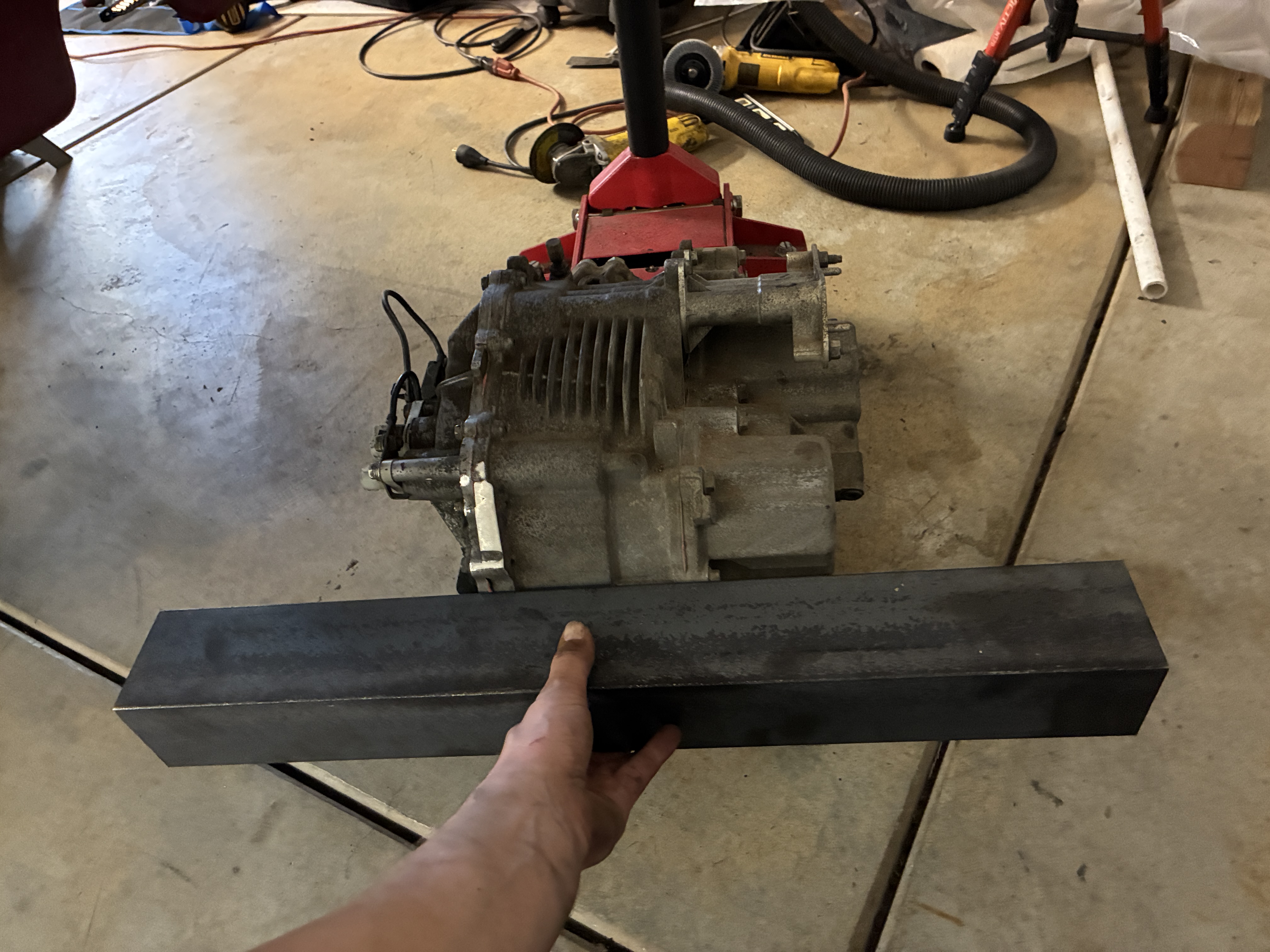

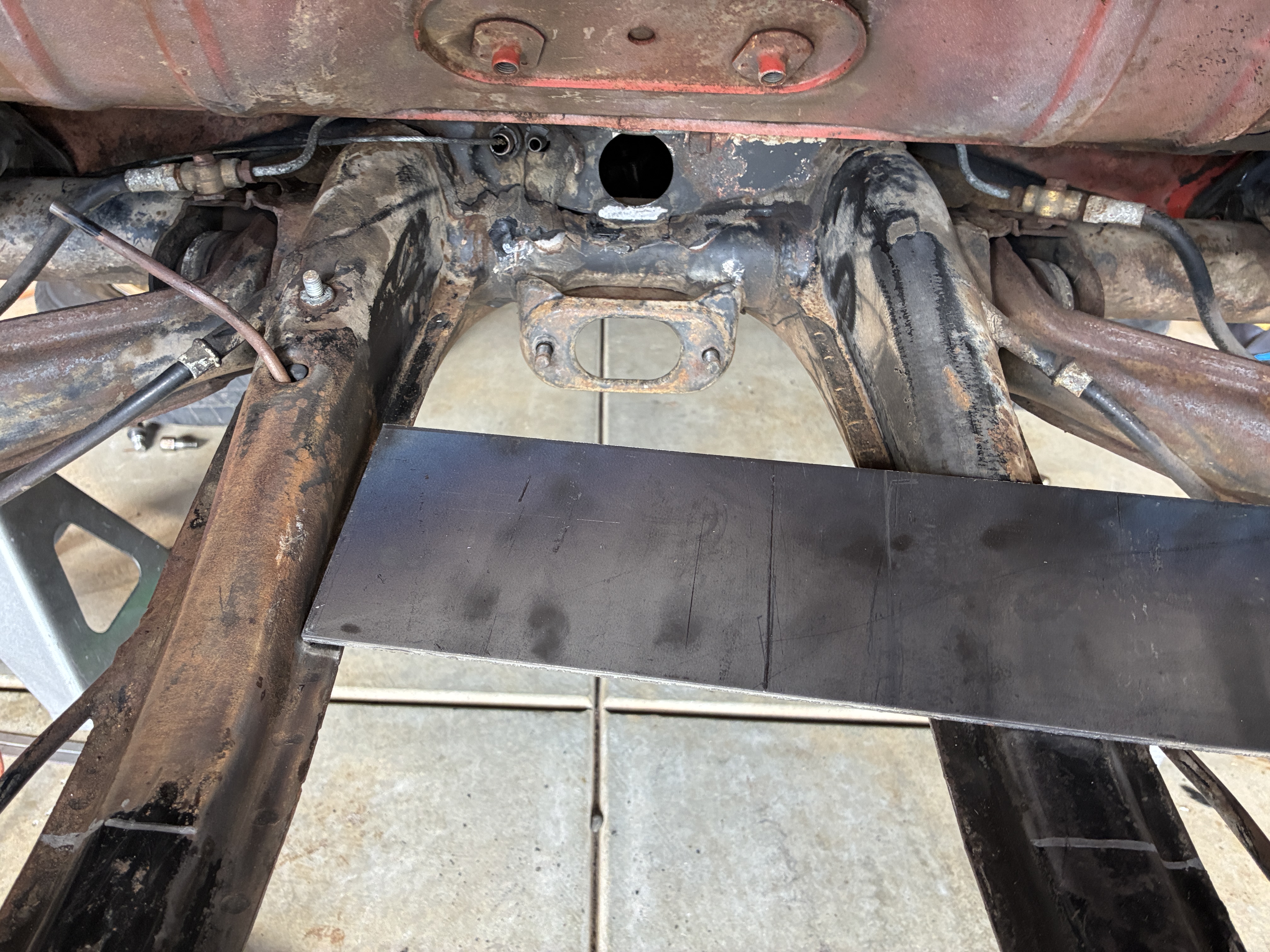

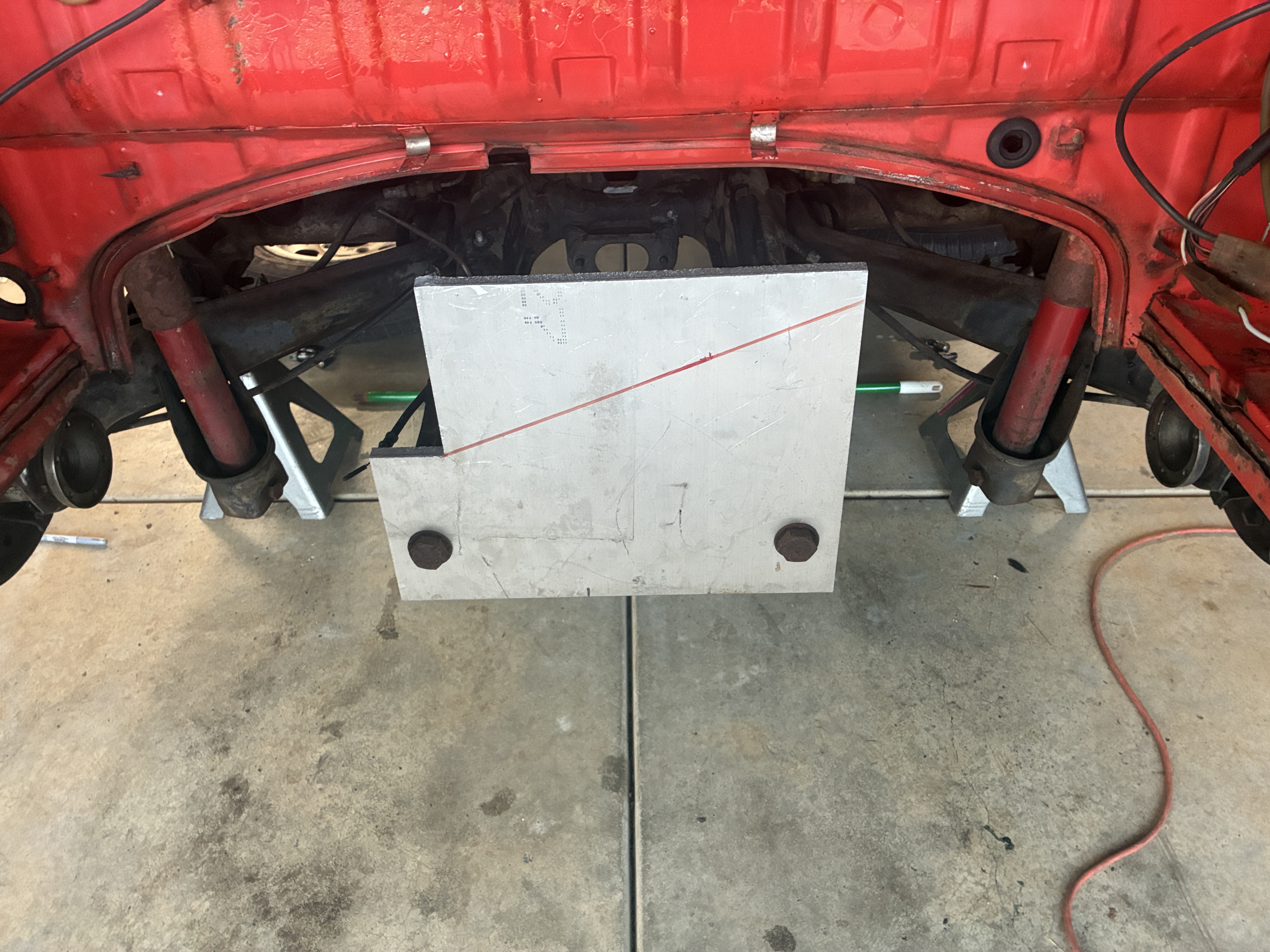

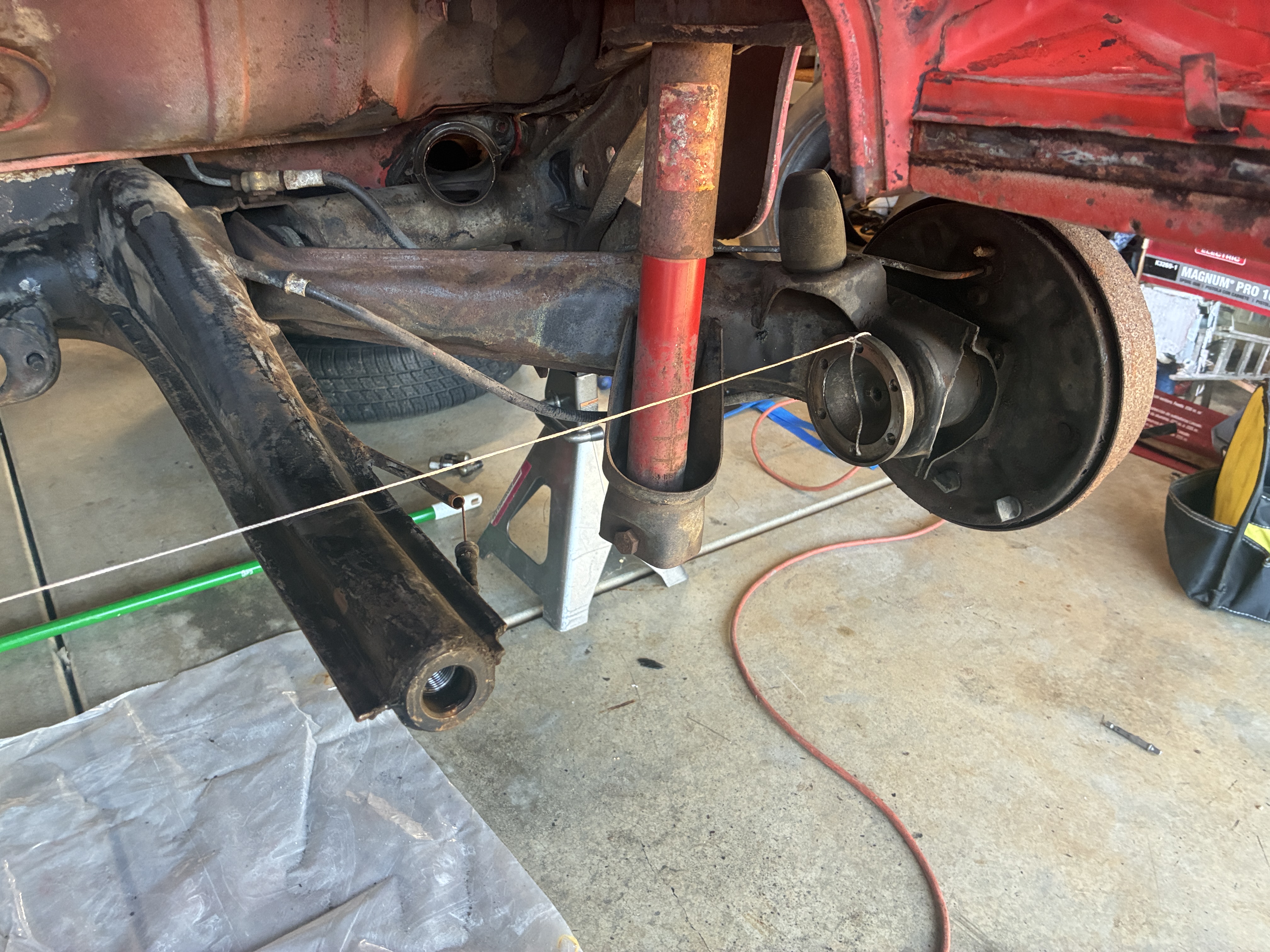

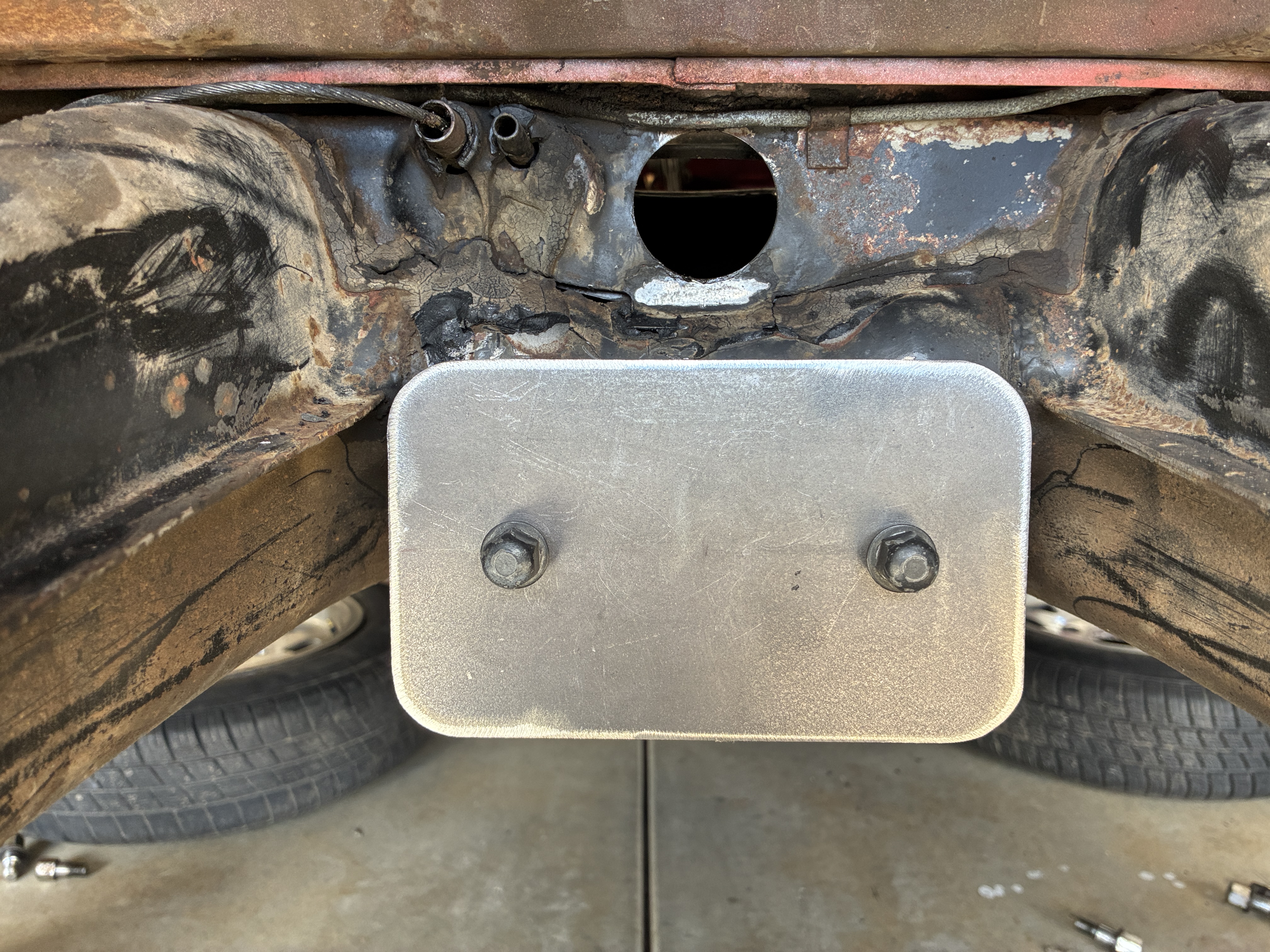

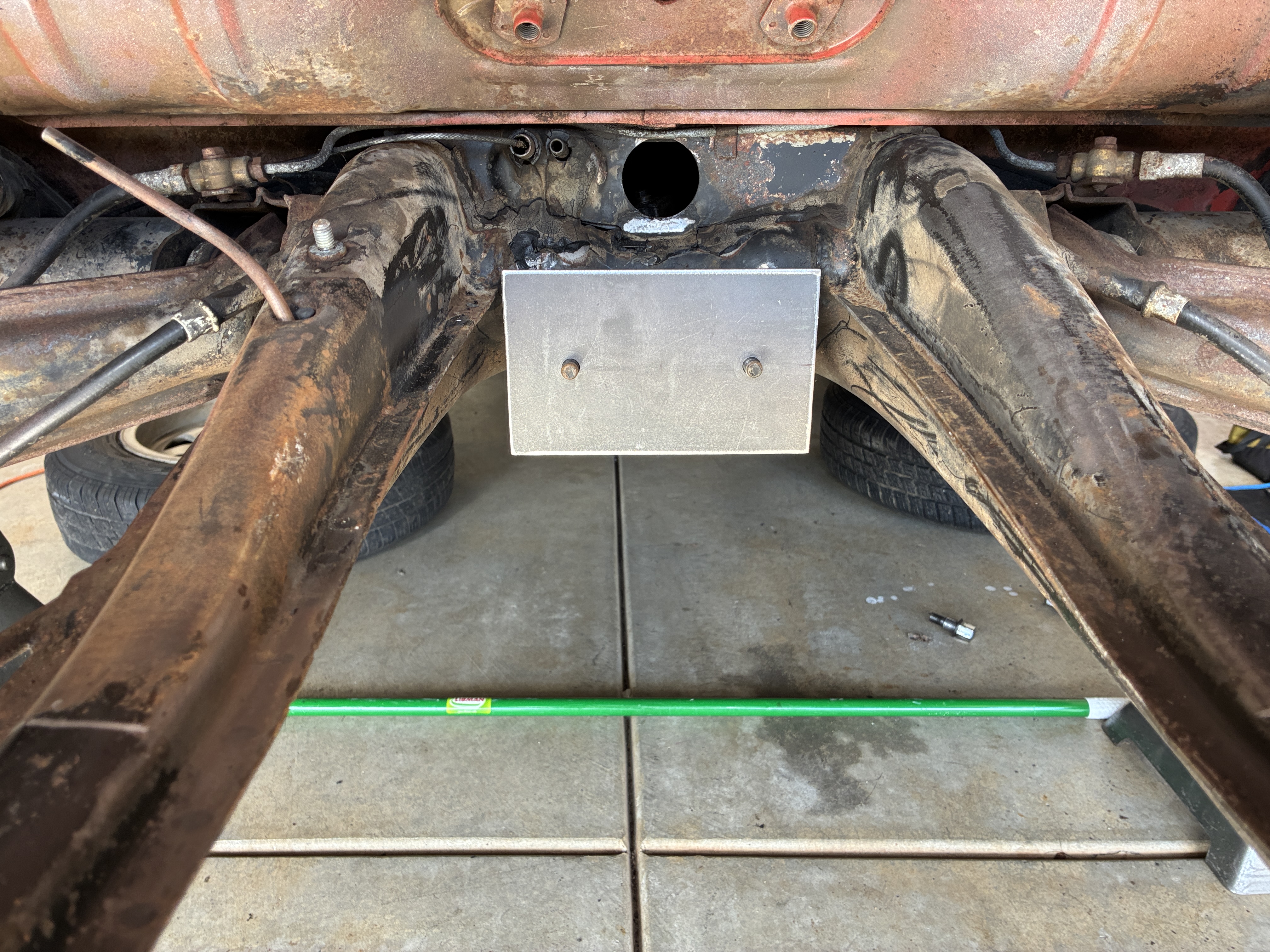

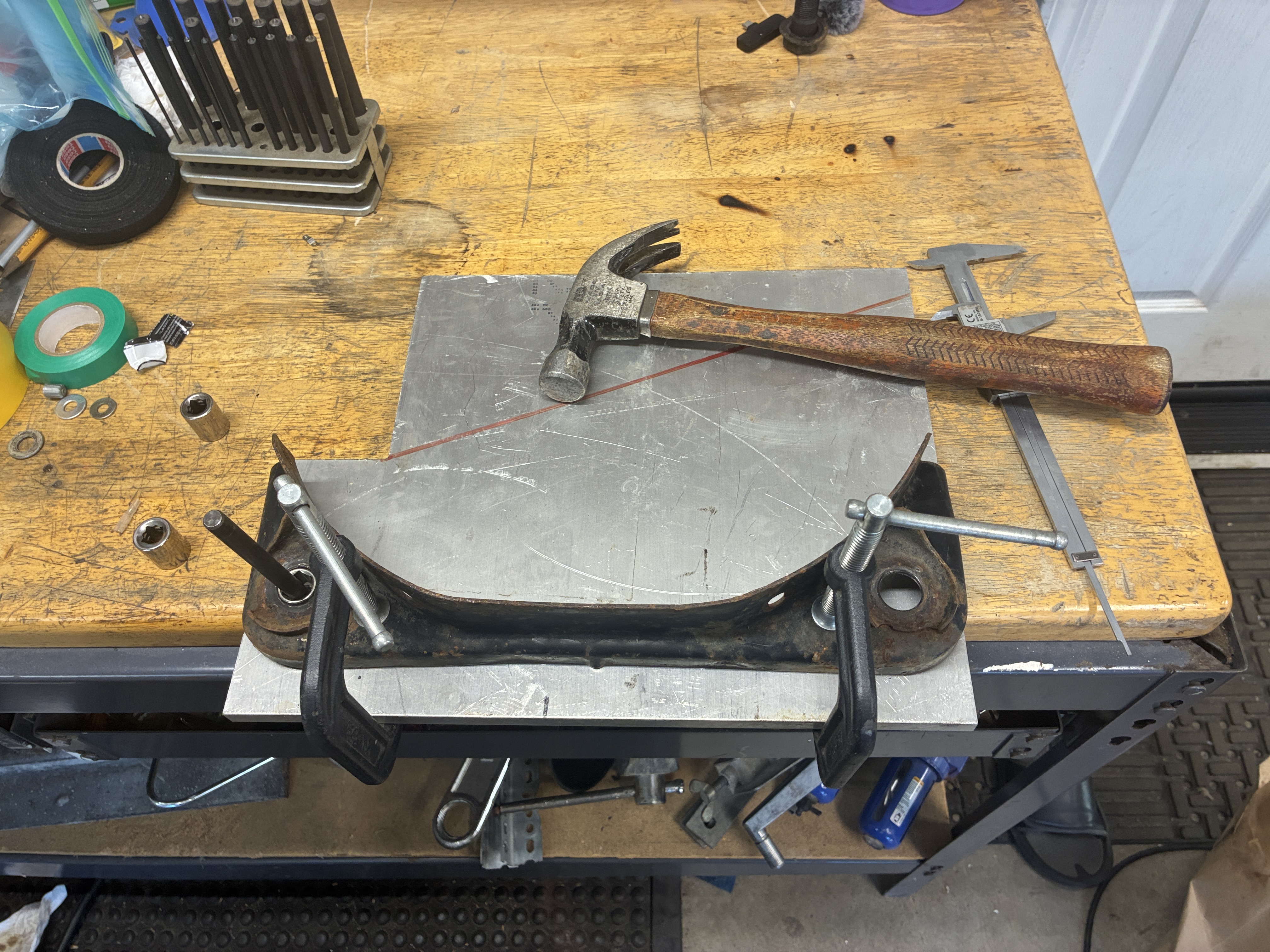

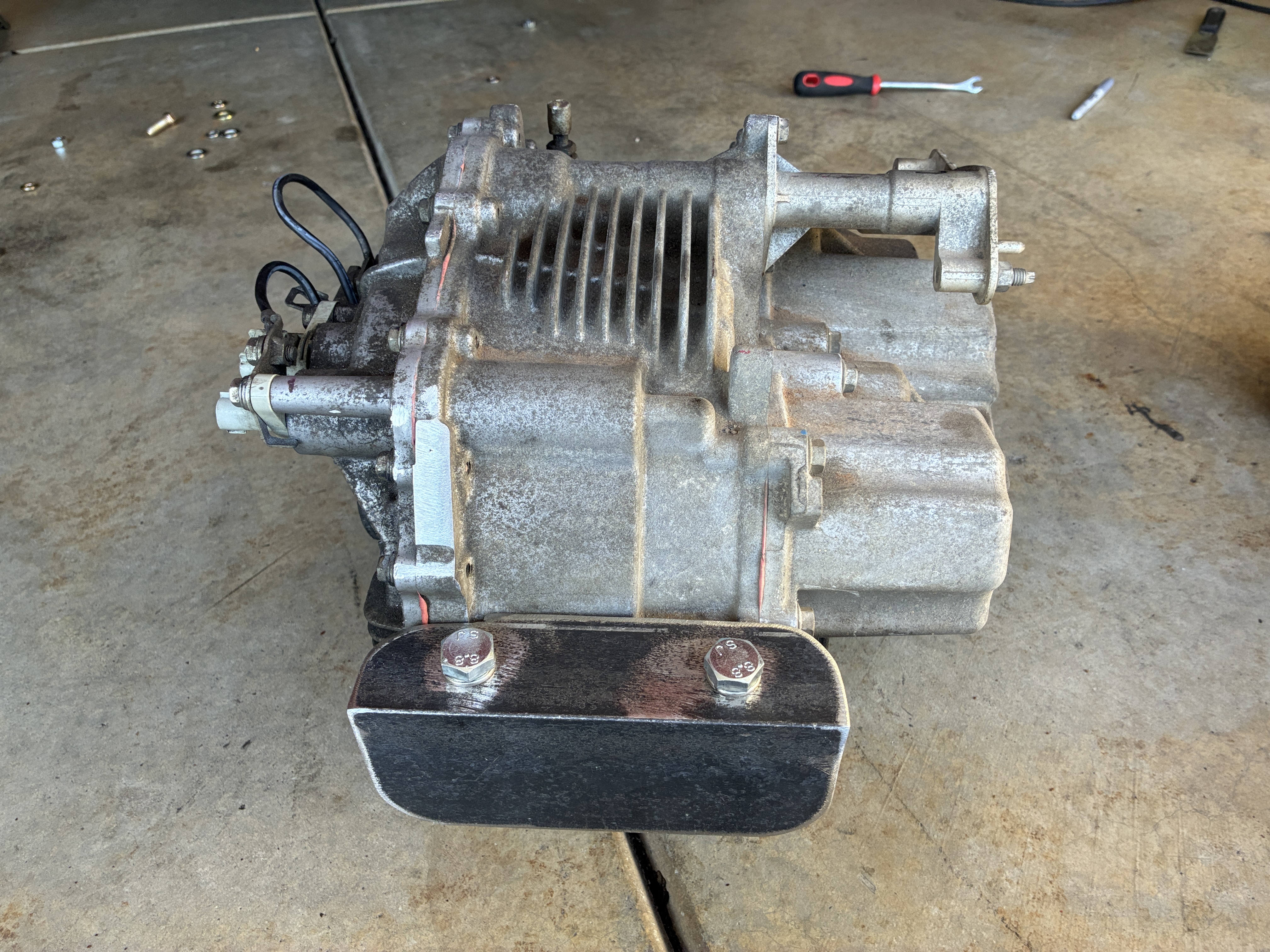

Front Plate: this aint our only option, but we're going for simple first, hoping we can come up with a bolt on kit, no welding required

here, I'm using the stock OEM transmission bellhousing bracket as a template for the holes

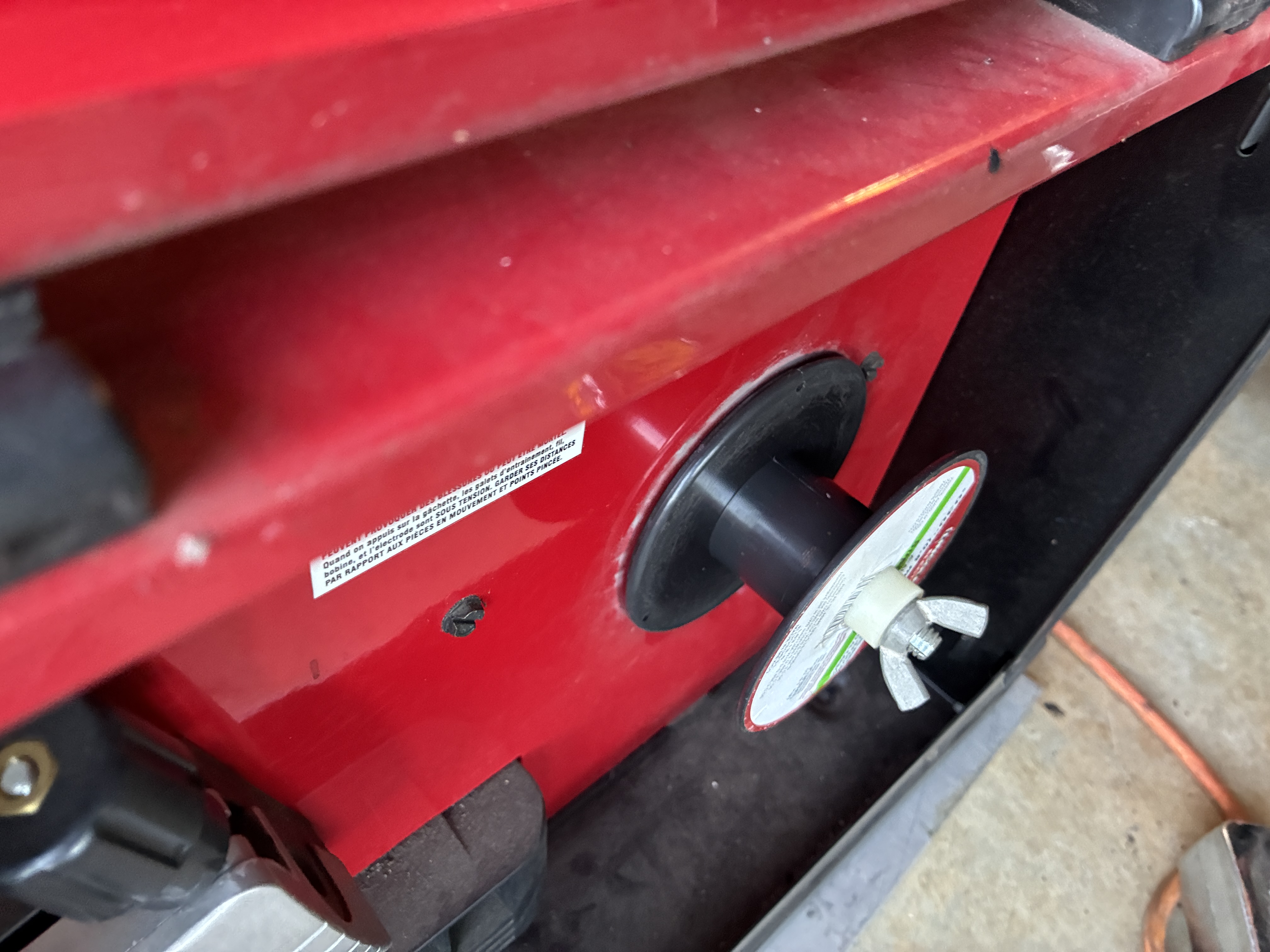

please ignore that diagonal red line, it's from a prior project
"I don't need to understand how it works, I just need to understand how to make it work!" ~ EV Greg
User avatar
Bratitude
Posts: 1156
Joined: Thu Jan 02, 2020 7:35 pm
Location: Canada
Has thanked: 246 times
Been thanked: 469 times
Contact:

Re: Bunky the eBug: A 30 Day EV Conversion

Post by Bratitude »

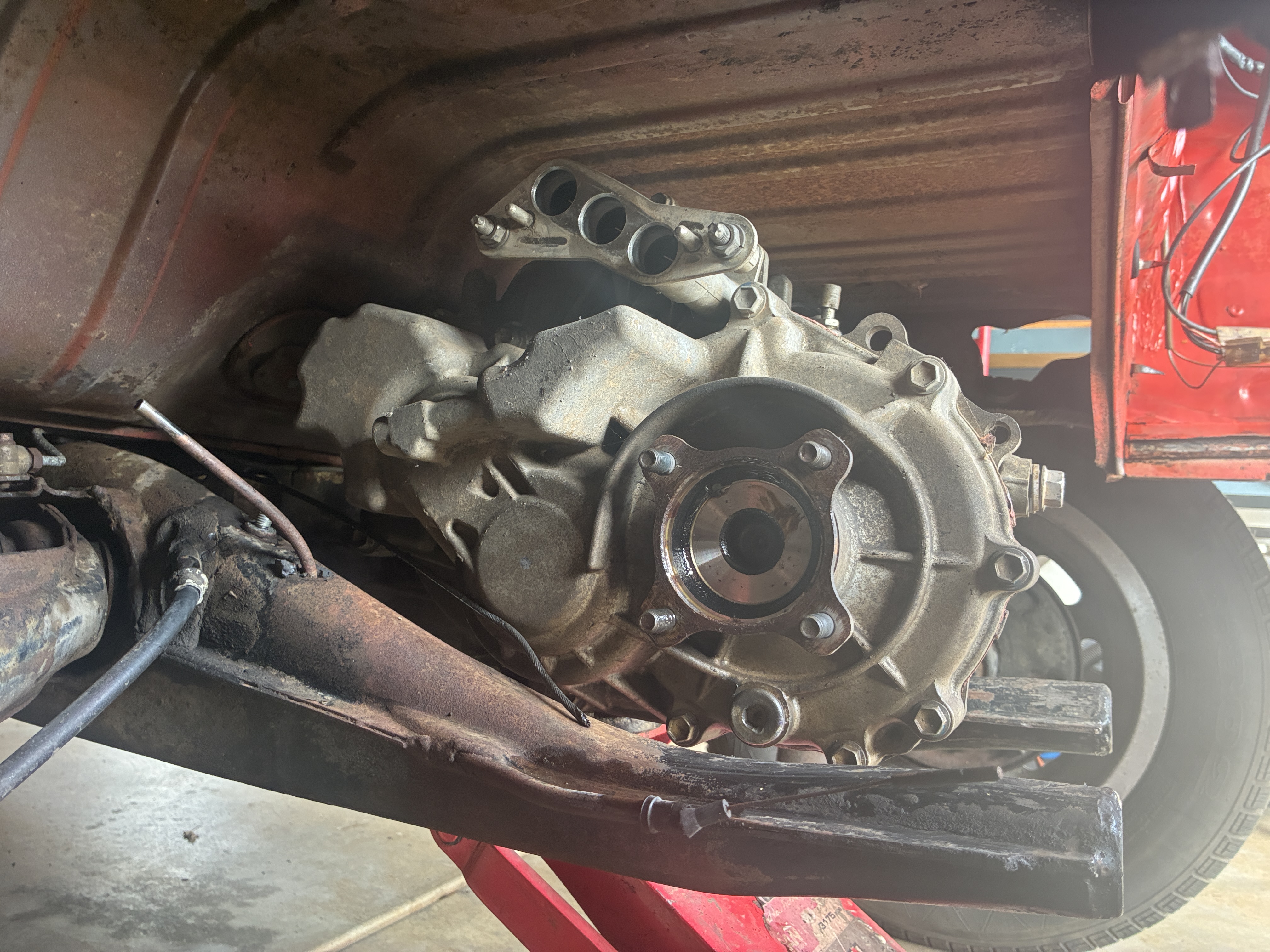

I hope you dont cut and splice axles, as a simple adapter flange is all you need to keep stock vw axles!
https://bratindustries.net/ leaf motor couplers, adapter plates, custom drive train components
User avatar
Gregski
Posts: 3164
Joined: Tue Sep 14, 2021 10:28 am
Location: Sacramento, California
Has thanked: 633 times
Been thanked: 1610 times
Contact:

Re: Bunky the eBug: A 30 Day EV Conversion

Post by Gregski »

Bratitude wrote: Mon Mar 02, 2026 6:36 pm I hope you dont cut and splice axles, as a simple adapter flange is all you need to keep stock vw axles!

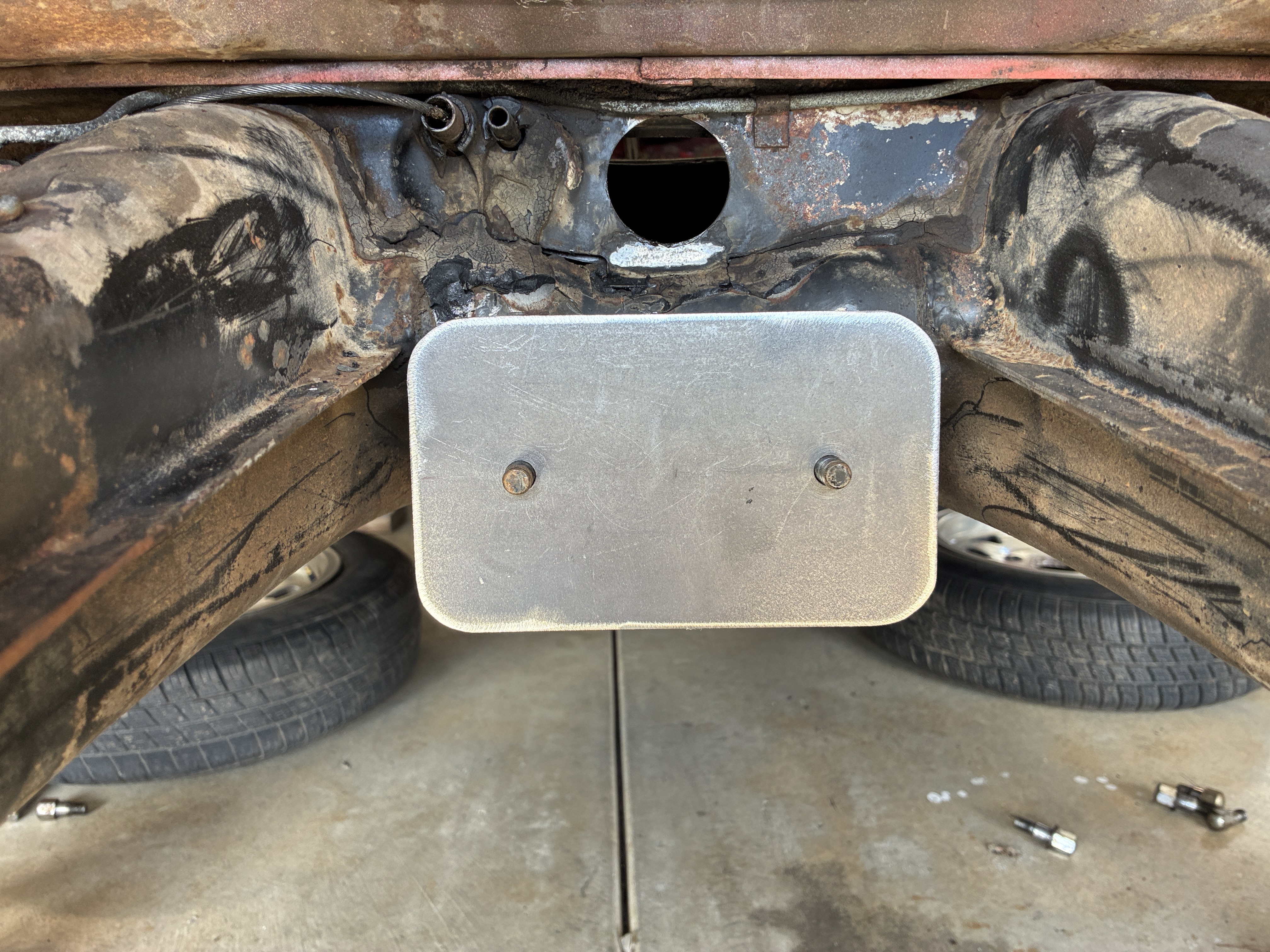

watchu talking about willis.jpg
"I don't need to understand how it works, I just need to understand how to make it work!" ~ EV Greg
User avatar
Gregski
Posts: 3164
Joined: Tue Sep 14, 2021 10:28 am
Location: Sacramento, California
Has thanked: 633 times
Been thanked: 1610 times
Contact:

Re: Bunky the eBug: A 30 Day EV Conversion

Post by Gregski »

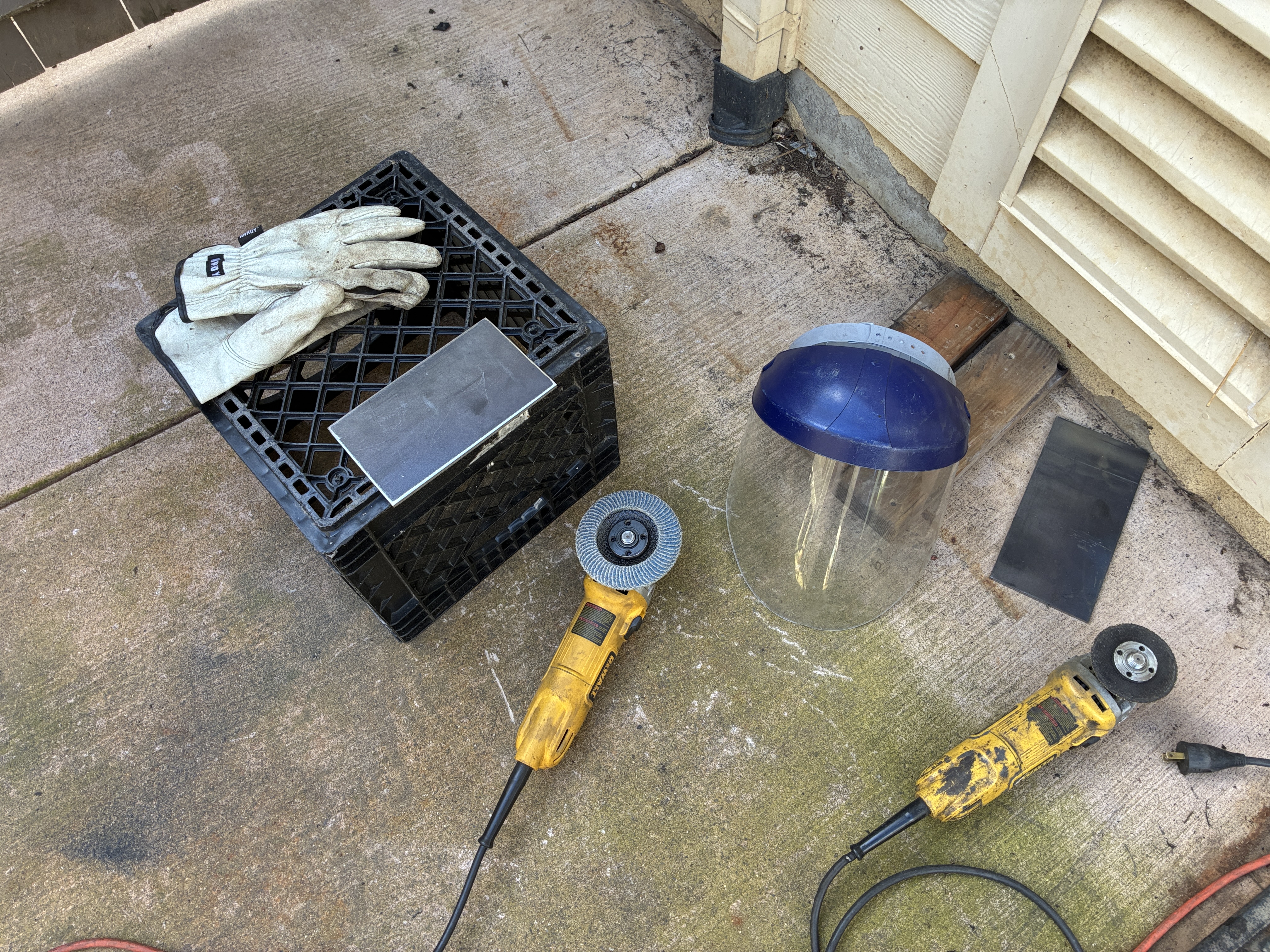

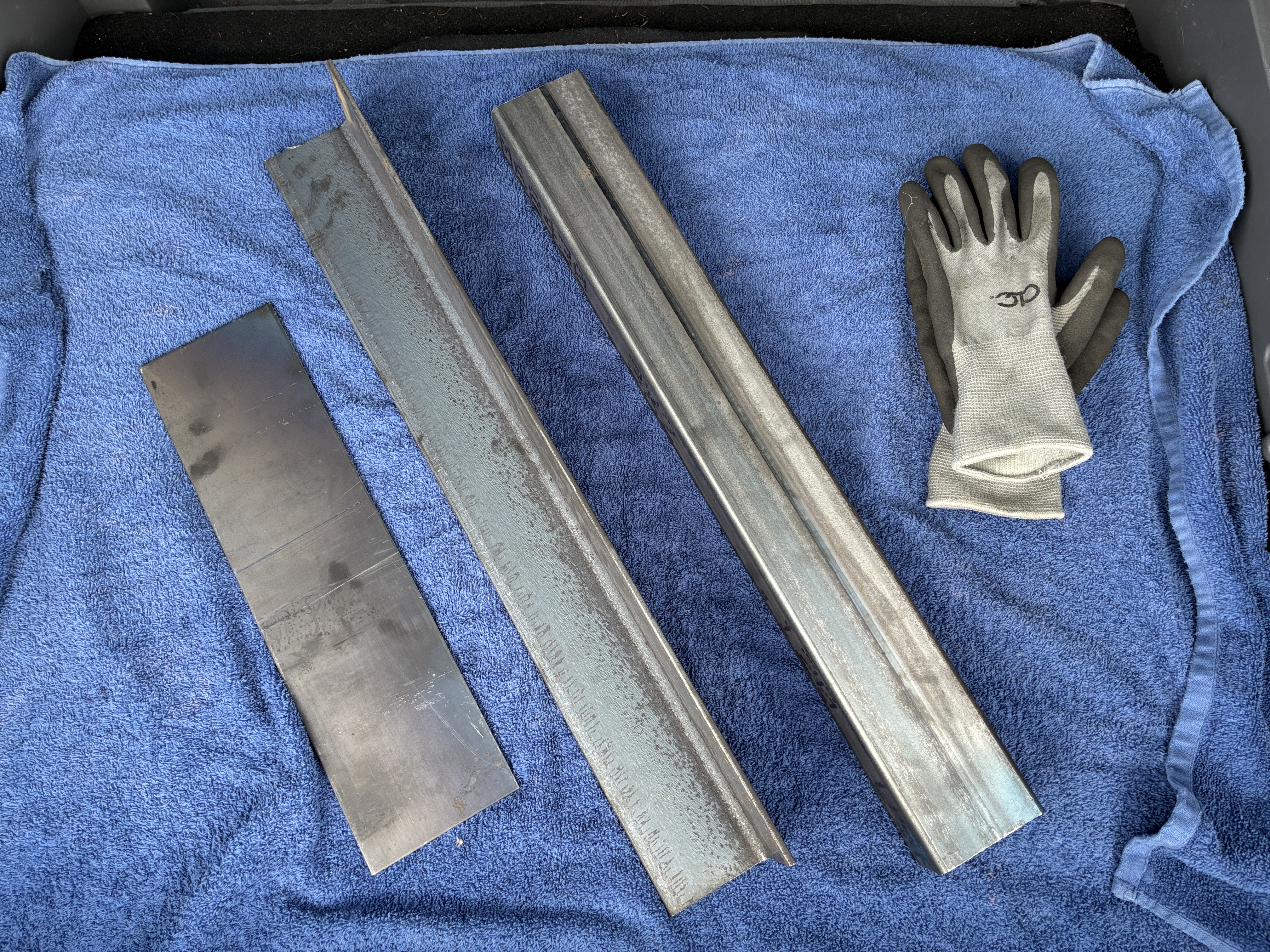

swung by my favorite mom n pop steel place today, may be the last one of it's kind, North of the Mmiissiissiippii

I love it cause they sell remnants, and let you wonder around their yard and warehouse aimlessly, so this is what $20 bones buys you these days, not too shabby at all, 3/16th" flat and angle, and 1/8th" rectangular tubing (gloves not included)

IMG_6204 - Copy.JPG
IMG_6202 - Copy.JPG
"I don't need to understand how it works, I just need to understand how to make it work!" ~ EV Greg
User avatar
Gregski
Posts: 3164
Joined: Tue Sep 14, 2021 10:28 am
Location: Sacramento, California
Has thanked: 633 times
Been thanked: 1610 times
Contact:

Re: Bunky the eBug: A 30 Day EV Conversion

Post by Gregski »

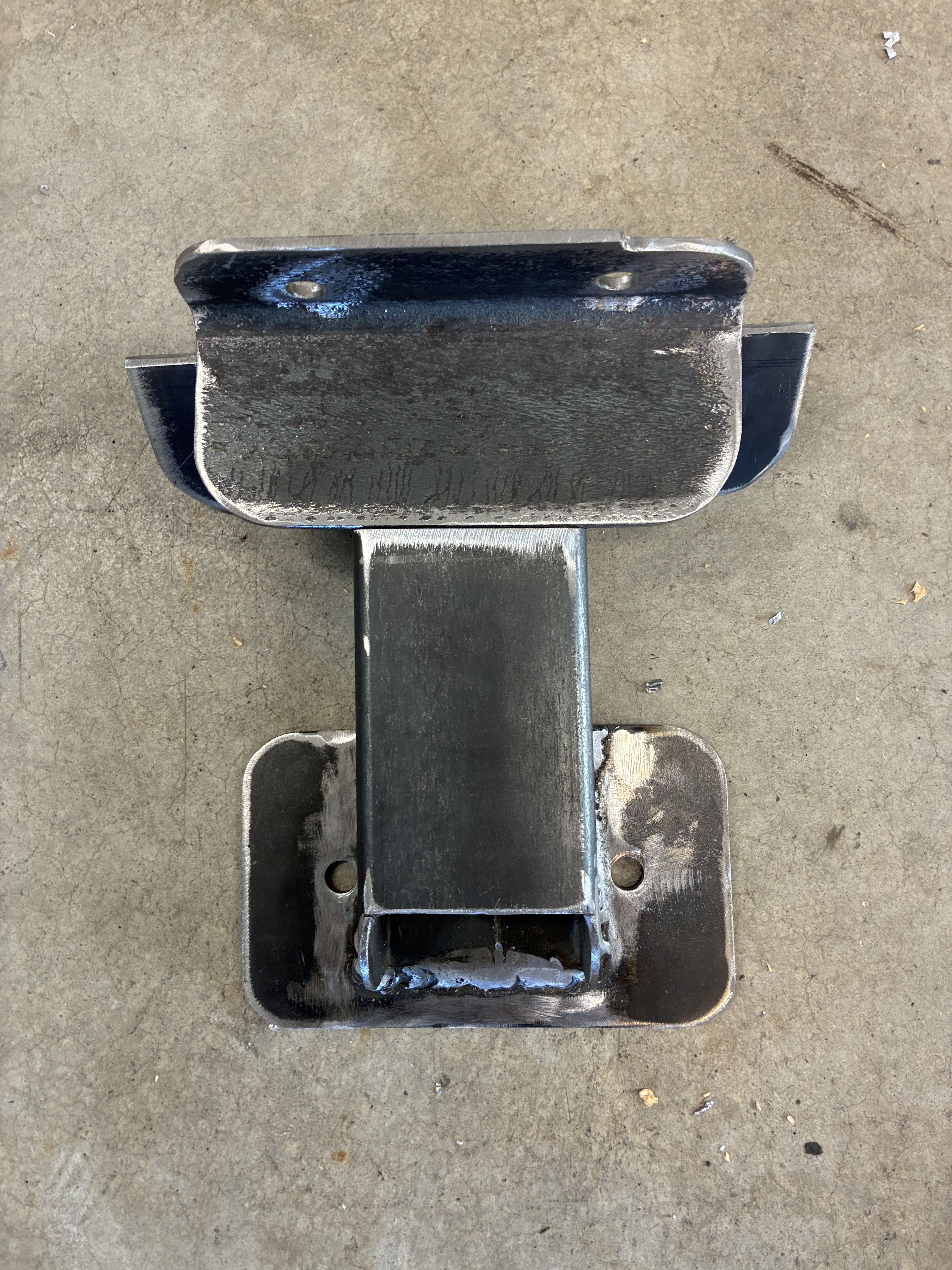

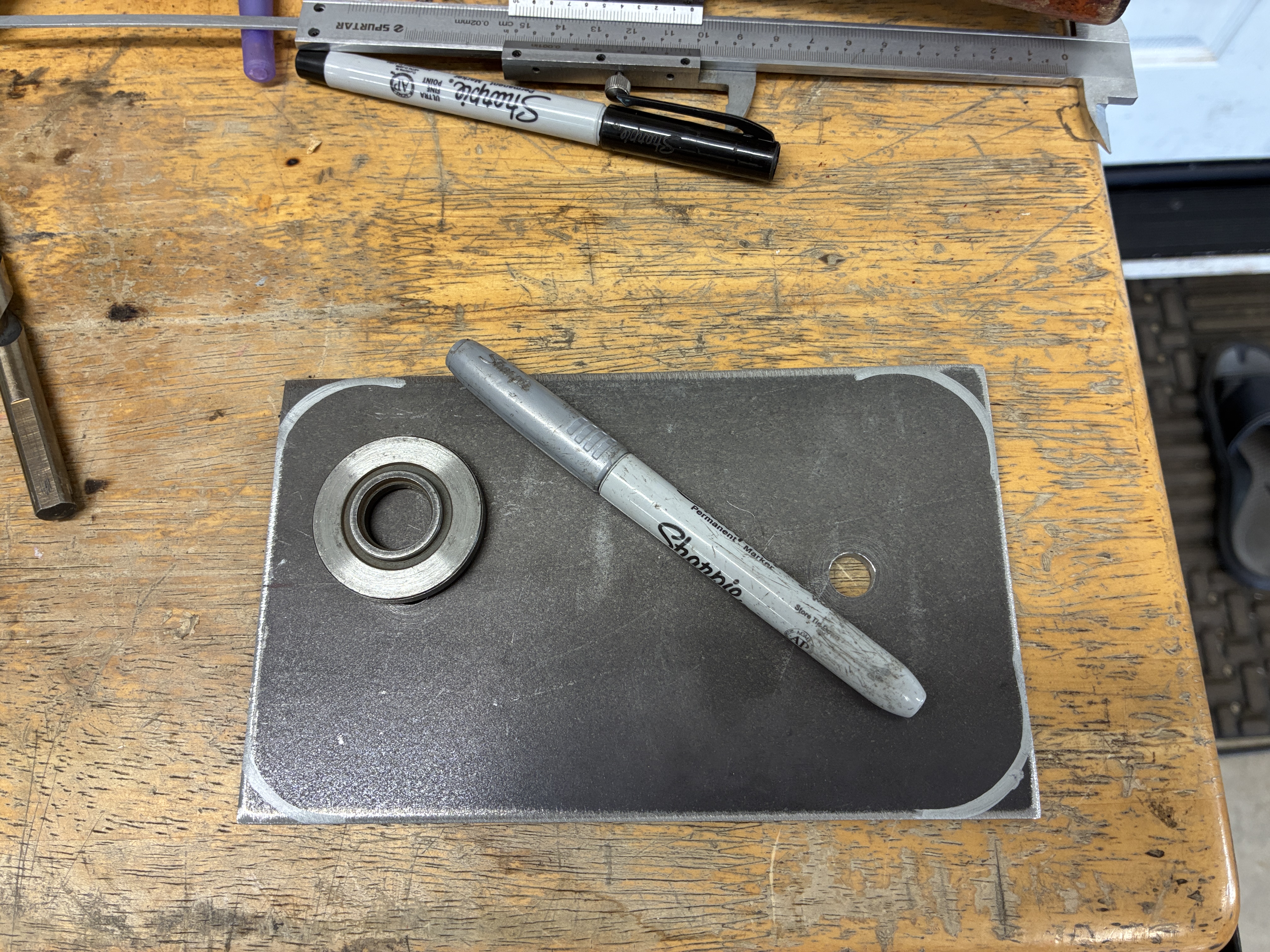

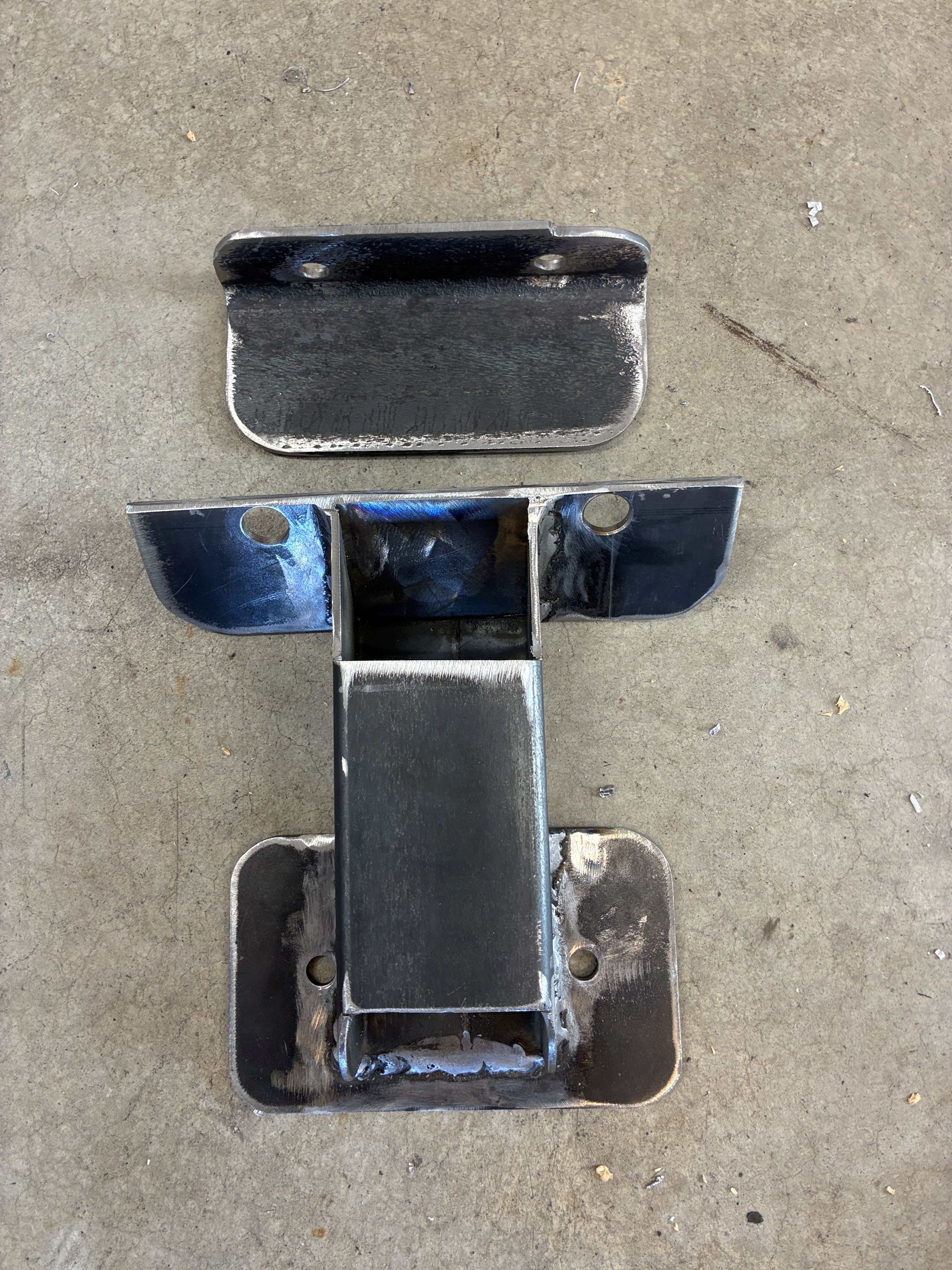

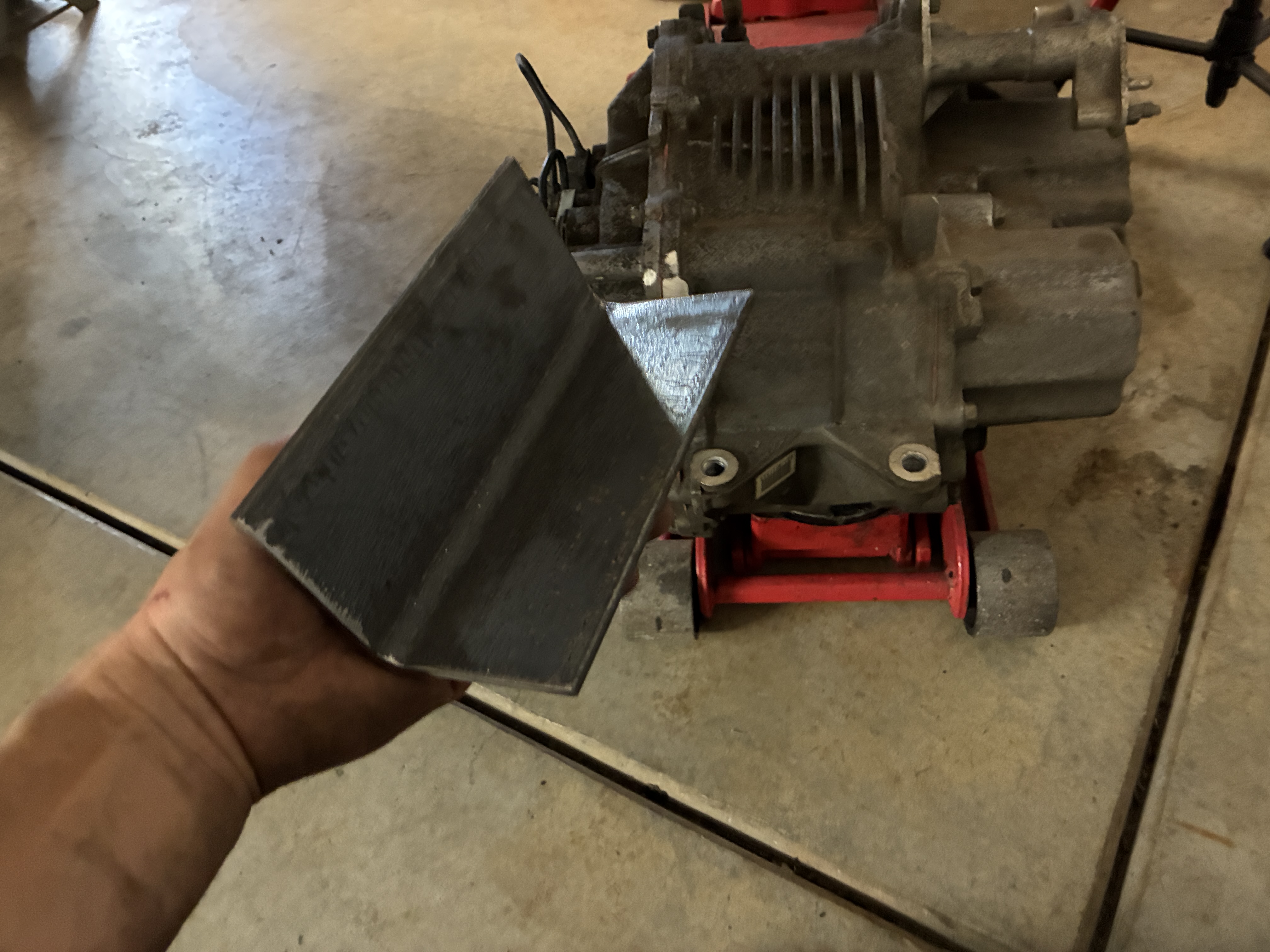

today we focus on the front motor bracket, and since it needs an odd offset and slant at an angle (all to be explained in the coming soon video) we opted to use the much cheaper and bugger welder friendly steel

IMG_6208 - Copy.JPG
IMG_6206 - Copy.JPG

and then it was off to Send Hack Send...
IMG_6210 - Copy.JPG
IMG_6212 - Copy.JPG

for the love of God, can somebody please move that annoying green broom stick!
IMG_6214 - Copy.JPG

we don't just cut corners here at the Good Enuff Garage, we round them !
IMG_6216 - Copy.JPG
IMG_6218 - Copy.JPG
IMG_6220 - Copy.JPG

I had the toughest time finding the right 10mm pitch nuts for these two studs
IMG_6222 - Copy.JPG

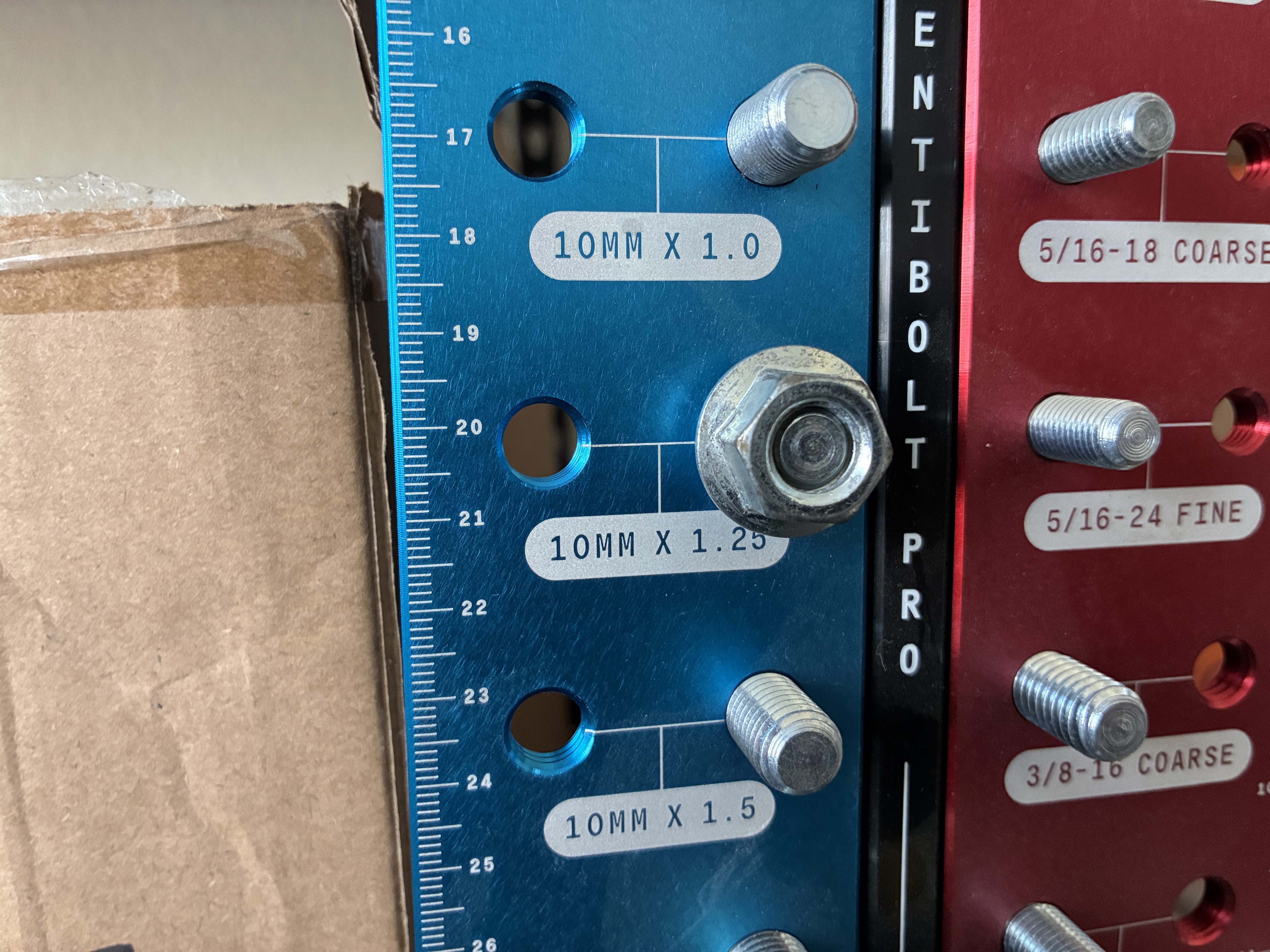

here I'm using my super duper favorite and best nut identifier thingie, I absolutely love this thing, so I used it here to narrow it down to an M10 but as it turned out it was the 1.50 thread
"I don't need to understand how it works, I just need to understand how to make it work!" ~ EV Greg
User avatar
Gregski
Posts: 3164
Joined: Tue Sep 14, 2021 10:28 am
Location: Sacramento, California
Has thanked: 633 times
Been thanked: 1610 times
Contact:

Re: Bunky the eBug: A 30 Day EV Conversion

Post by Gregski »

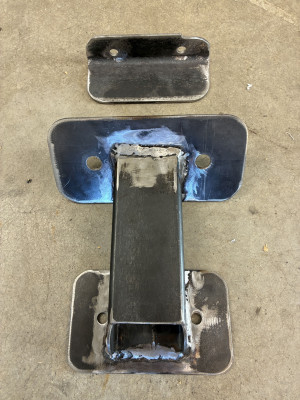

the vertical piece was next, but we'll have to wait till tomorrow for the finished product, wonder why ?

IMG_6233 - Copy.JPG

I swear, never fails !!!

"I don't need to understand how it works, I just need to understand how to make it work!" ~ EV Greg
MattsAwesomeStuff
Posts: 1084
Joined: Fri Apr 26, 2019 5:40 pm
Has thanked: 479 times
Been thanked: 314 times

Re: Bunky the eBug: A 30 Day EV Conversion

Post by MattsAwesomeStuff »

Gregski wrote: Thu Feb 26, 2026 2:25 pmhere's the proposed Bunky Build Schedule ... I doubt I will be able to wrench on Bunky for 12 consecutive weekends
Wait, hol up. Is that how we're counting days now for this "30-day build"? As if they're billable hours on a law firm, and the time elapsed is just on retainer?

And people think this is a legitimate way of describing automotive projects?

*wipes forehead*

Whew. This makes my 7 year long conversion more like a 2 month conversion. Easy peasey. Heck, at 2 months it technically still qualifies as a "summer project"!

I've had it all wrong. I've been using spouse-days to measure my (lack of) progress. Spouse-days of course being how long this unfinished, torn apart, POS vehicle has been sitting on the lawn/driveway/garage, being an eyesore and taking up space and not fulfilling its role as an object that benefits their lives and accomplishes things like transporting people and products.

Neither I nor you currently have a spouse, so, your argument is very convincing to me at the moment. Derelict vehicles? No. I'm surrounded by treasures of my own choosing.
User avatar
Gregski
Posts: 3164
Joined: Tue Sep 14, 2021 10:28 am
Location: Sacramento, California
Has thanked: 633 times
Been thanked: 1610 times
Contact:

Re: Bunky the eBug: A 30 Day EV Conversion

Post by Gregski »

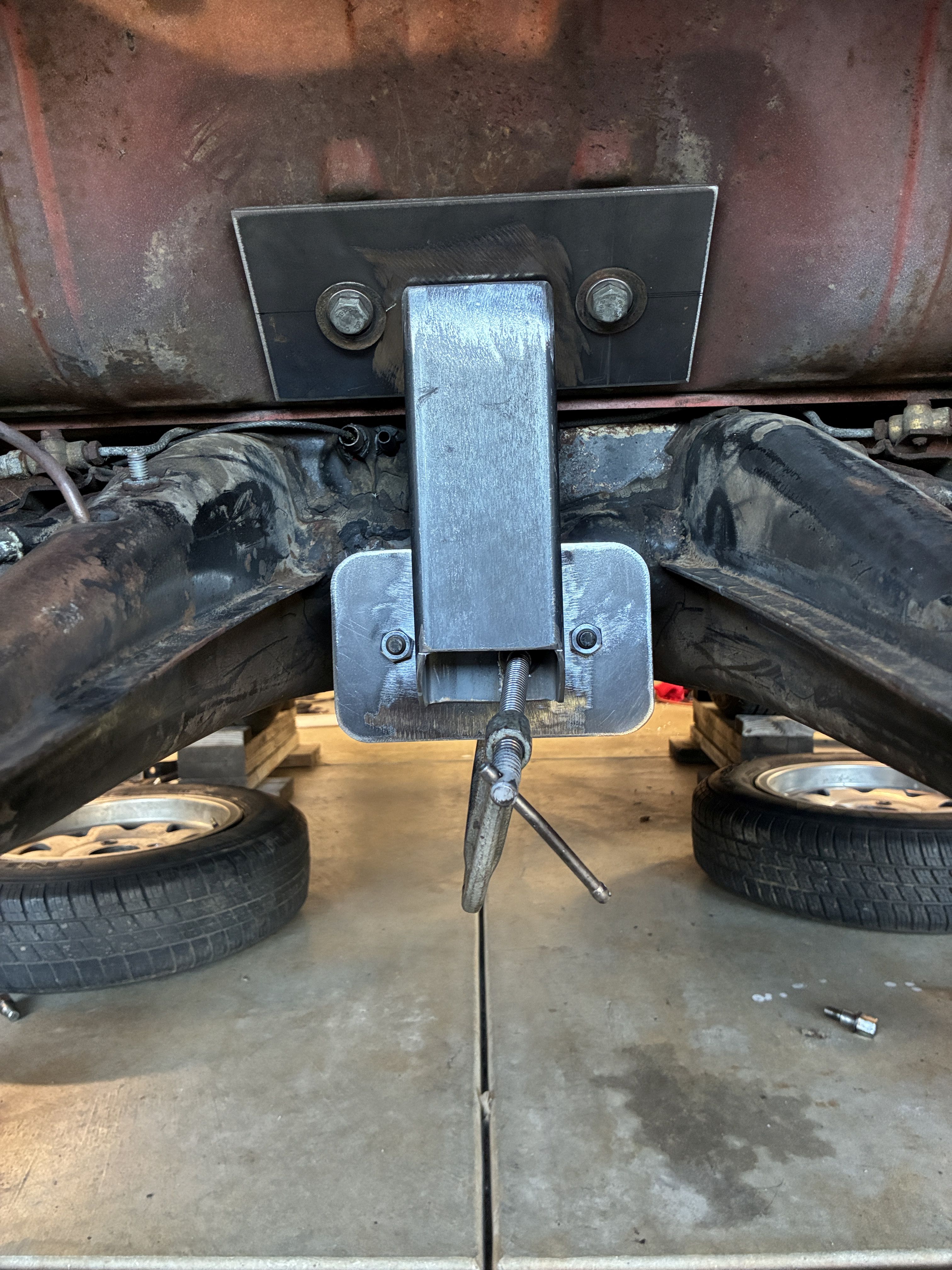

then it was time to work on the piece that would attach to the front of the little MGR

a chunk of 3" angle iron 3/16ths thick
IMG_6273 - Copy.JPG
IMG_6275 - Copy.JPG
IMG_6277 - Copy.JPG
IMG_6279 - Copy.JPG

we round the edges cause we're not Barbarians!
IMG_6298 - Copy.JPG
IMG_6300 - Copy.JPG

we needed some shorter M12 x 1.25 bolts
IMG_6290 - Copy.JPG
IMG_6292 - Copy.JPG
"I don't need to understand how it works, I just need to understand how to make it work!" ~ EV Greg
User avatar
Gregski
Posts: 3164
Joined: Tue Sep 14, 2021 10:28 am
Location: Sacramento, California
Has thanked: 633 times
Been thanked: 1610 times
Contact:

Re: Bunky the eBug: A 30 Day EV Conversion

Post by Gregski »

all welded up this pretty little thing had no idea what was coming...

IMG_6271 - Copy.JPG
IMG_6281 - Copy.JPG

death by a thousand cuts !
IMG_6284 - Copy.JPG

yes that cut was crooked, I aligned the straight edge with the cab, silly me! (I corrected it with a speed square later)
IMG_6286 - Copy.JPG
IMG_6288 - Copy.JPG
"I don't need to understand how it works, I just need to understand how to make it work!" ~ EV Greg
User avatar
Jack Bauer
Posts: 4006
Joined: Wed Dec 12, 2018 5:24 pm
Location: Ireland
Has thanked: 153 times
Been thanked: 1135 times
Contact:

Re: Bunky the eBug: A 30 Day EV Conversion

Post by Jack Bauer »

Greg, you have a truck. What in the sam hill are you doing pushing a car up a hill :)
I'm going to need a hacksaw
User avatar
Gregski
Posts: 3164
Joined: Tue Sep 14, 2021 10:28 am
Location: Sacramento, California
Has thanked: 633 times
Been thanked: 1610 times
Contact:

Re: Bunky the eBug: A 30 Day EV Conversion

Post by Gregski »

Jack Bauer wrote: Wed Mar 04, 2026 9:20 am Greg, you have a truck. What in the sam hill are you doing pushing a car up a hill :)
LoL, obviously working harder not smarter!
"I don't need to understand how it works, I just need to understand how to make it work!" ~ EV Greg
MattsAwesomeStuff
Posts: 1084
Joined: Fri Apr 26, 2019 5:40 pm
Has thanked: 479 times
Been thanked: 314 times

Re: Bunky the eBug: A 30 Day EV Conversion

Post by MattsAwesomeStuff »

Jack Bauer wrote: Wed Mar 04, 2026 9:20 amGreg, you have a truck. What in the sam hill are you doing pushing a car up a hill :)
Haven't you heard? His truck is an EV.

... doesn't have the range...
Alibro
Posts: 1113
Joined: Sun Feb 23, 2020 9:24 am
Location: Northern Ireland
Has thanked: 506 times
Been thanked: 325 times
Contact:

Re: Bunky the eBug: A 30 Day EV Conversion

Post by Alibro »

Subbed
If this crazy idiot is mad enough to 1, start a third EV project and 2, attempt to complete it (get it driving as nobody ever completes an EV project) in 30 days then the least I can do is be here to mock/deride/hurl abuse//praise/criticize etc
Alibro
Posts: 1113
Joined: Sun Feb 23, 2020 9:24 am
Location: Northern Ireland
Has thanked: 506 times
Been thanked: 325 times
Contact:

Re: Bunky the eBug: A 30 Day EV Conversion

Post by Alibro »

Subbed
If this crazy idiot is mad enough to 1, start a third EV project and 2, attempt to complete it (get it driving as nobody ever completes an EV project) in 30 days then the least I can do is be here to mock/deride/hurl abuse//praise (never gonna happen) as required
Post Reply
